Content Pack Overview

If you are using Project Online (PJO) then you are probably using the OData feed for reporting purposes, the two most common options being to bring the data into Excel or Power BI. Both applications have their pros and cons, though one of the big advantages with Power BI is that Microsoft has provided a pre-defined content pack for the last few years. Even better, my company has been able to directly access it and modify it for our own purposes (For information on how to get hold of MS’ Content Pack please see Brian Smith’s post here).

One of the issues with Microsoft’s original content pack was that it only supported US-English, so if your PWA instance was created in a different language, the content pack would simply not work for you. Microsoft; however, listened to its customers and has recently updated the content pack to support five additional languages. Namely French, German, Portuguese (Brazil), Portuguese (Portugal), and Spanish are now supported. Whilst Microsoft’s update of the content pack is to be welcomed, it still leaves many other international customers without the ability to natively use the content pack. This became plainly obvious when I was in the Ukraine recently presenting at Kyiv with my fellow MVP Oleksiy Prosnitskyy. Following up on my time with Oleksiy and some of the Microsoft personnel in the Ukraine and Russia, I decided to update the content pack with language support for both Ukrainian and Russian, so if you use my content pack, you can choose either of these two additional languages in addition to the ones already available.

Start with Downloading the Existing Content Pack

To download Microsoft’s content pack with the additional languages of Ukrainian and Russian, please follow this link. I’ll be using this content pack to show you how you can add your own language, though if you’d like my help with this please just email me and I’ll ensure it is added to my published content pack so that it can benefit everyone.

Modifying the Content Pack to Work with another Language

When you create your PWA instance, you are prompted to select the language. Given that I’ve been working in Copenhagen recently, I figured Danish would be great addition to my content pack. By the time you read this, Danish will have been added! You can follow this process outlined below to add your own language.

Create a New PWA Instance for Your Language

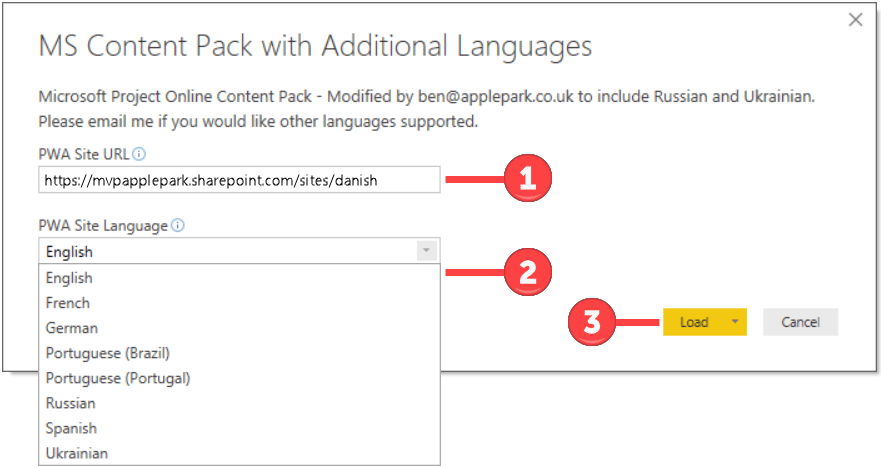

  1. The first thing to do is create a new PWA instance in the language you want to use the content pack against. In this case, Danish.

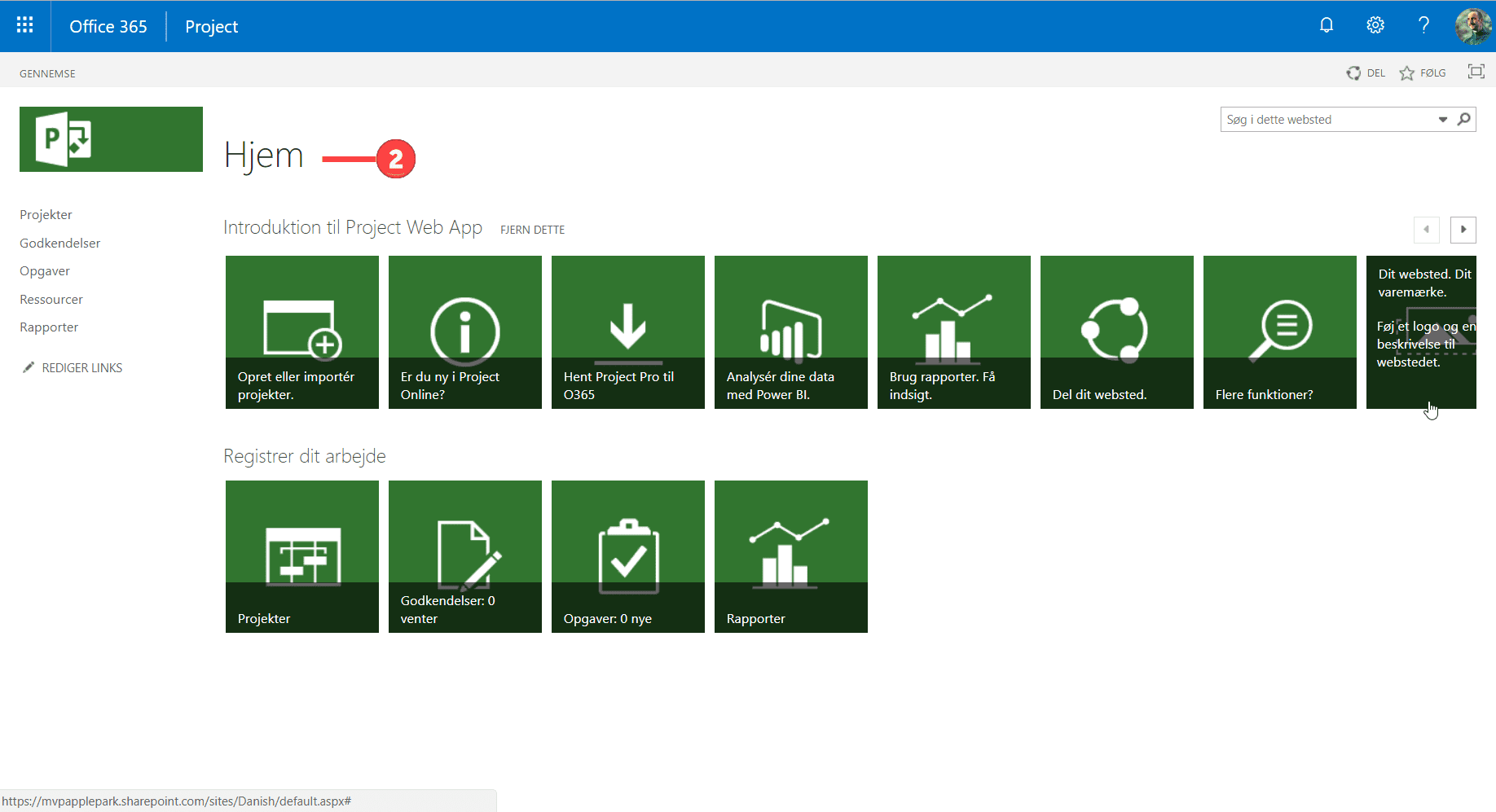

  1. Confirm that the site is created and displays in Danish.

Connect the Existing Content Pack to the New Instance

Next is a question of connecting existing content pack to the new instance to see what errors we get. To do this:

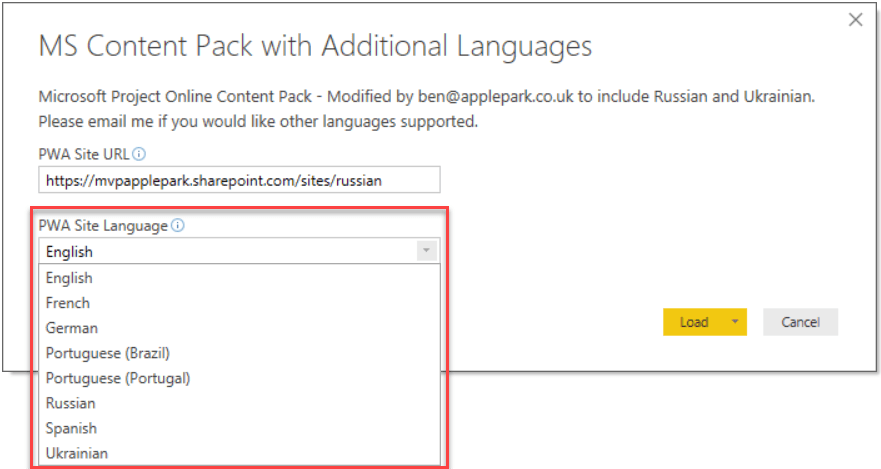

  1. Open the existing content pack template file and connect if to the new instance
  2. Set the PWA Site Language as English
  3. Click on the Load button.

Review the Existing Errors

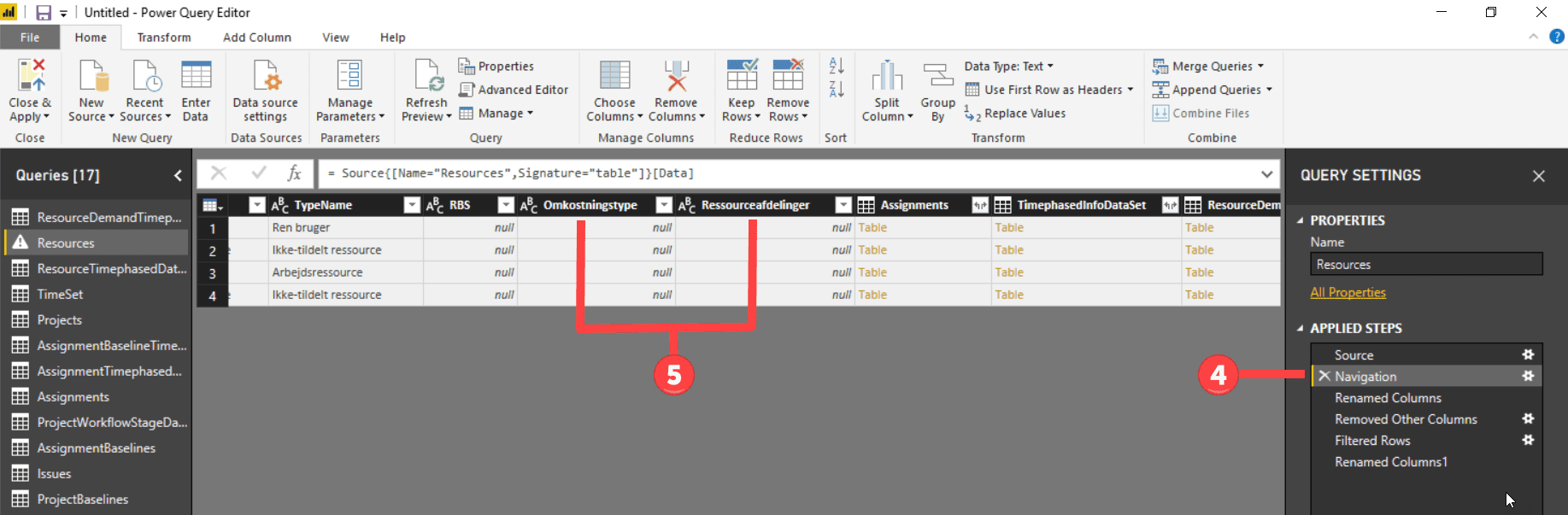

You’ll have to review the existing errors. Unsurprisingly, when the Content Pack tries to load the data, some errors pop up (see #1 below).

What’s happening here is that some of the column names that the Content Pack expects aren’t available because they’re in Danish. Our job is to determine the correct translations for these Danish terms and translate them back to English.  Now I don’t speak any Danish, but once you know your way around Power Query it’s pretty easy to make the translations and modify the query to support Danish. Not only that, but both https://translate.google.com/ and https://www.bing.com/translator do a pretty good job of telling you what’s what!  I’ve supplied a table below which defines which items are typically translated.

Use the Query Editor to Fix the Errors

Using the Query Editor, it is possible to identify and fix all the issues.

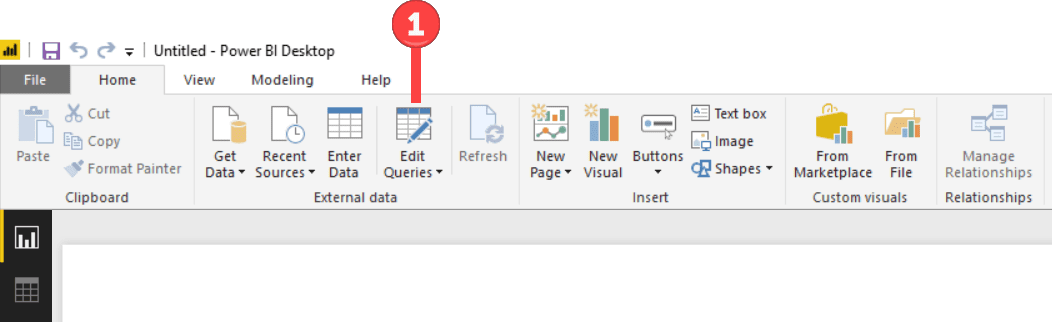

  1. Open the Query Editor in Power BI by selecting the Edit Queries button.

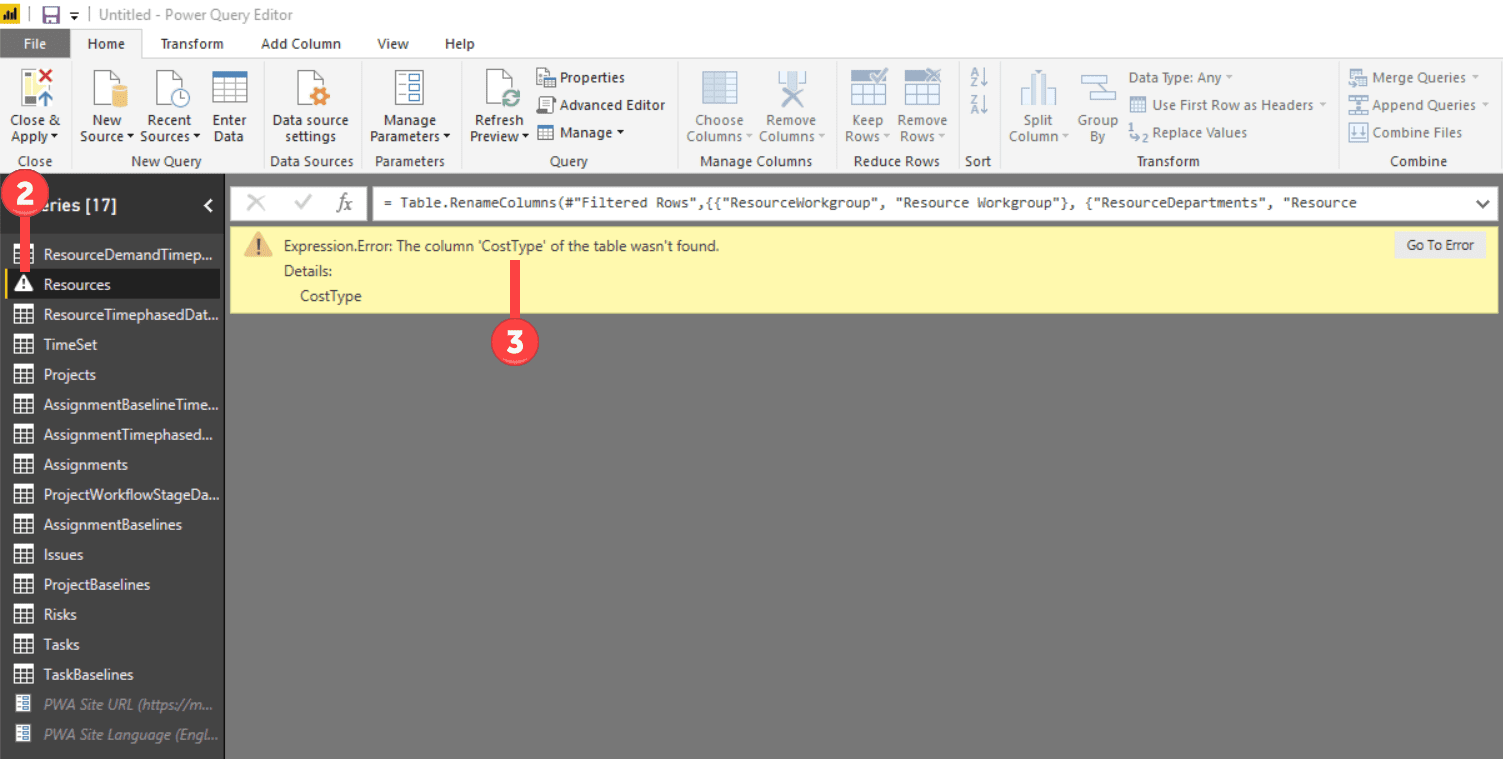

  1. Review the first error. You can immediately see the Query that has an error because of the icon with the exclamation mark to the right of the Query Name.
  2. Review the error and note the column name. In this case, the column that is causing the issue is called ‘CostType’.

  1. Click on the Navigation step within the Applied Steps.
  2. Scroll through the table to see the column headings and identify the headings that aren’t in English. In this case, I can see I have two columns called Omkostningstype and Ressourceafdelinger…somehow I suspect these might be the source of my issues.

Let’s turn back to https://www.bing.com/translator and see which one matches CostType. It turns out to be Omkostningstype. Whilst I’m there, I determine that Ressourceafdelinger translates to Resource Departments and note that in the table below.

Query English Danish
Resources CostType Omkostningstype
ResourceDepartments Ressourceafdelinger

Use the Advanced Editor to modify the Query

I’ve got my two “rogue” fields and the translations for them, but now I need to use the Advanced Editor to write some M-code, which will perform the translation. The term Advanced Editor is a bit of a non-statement, as the editor is anything but advanced.

  1. Click on the Advanced Editor button on the Ribbon.

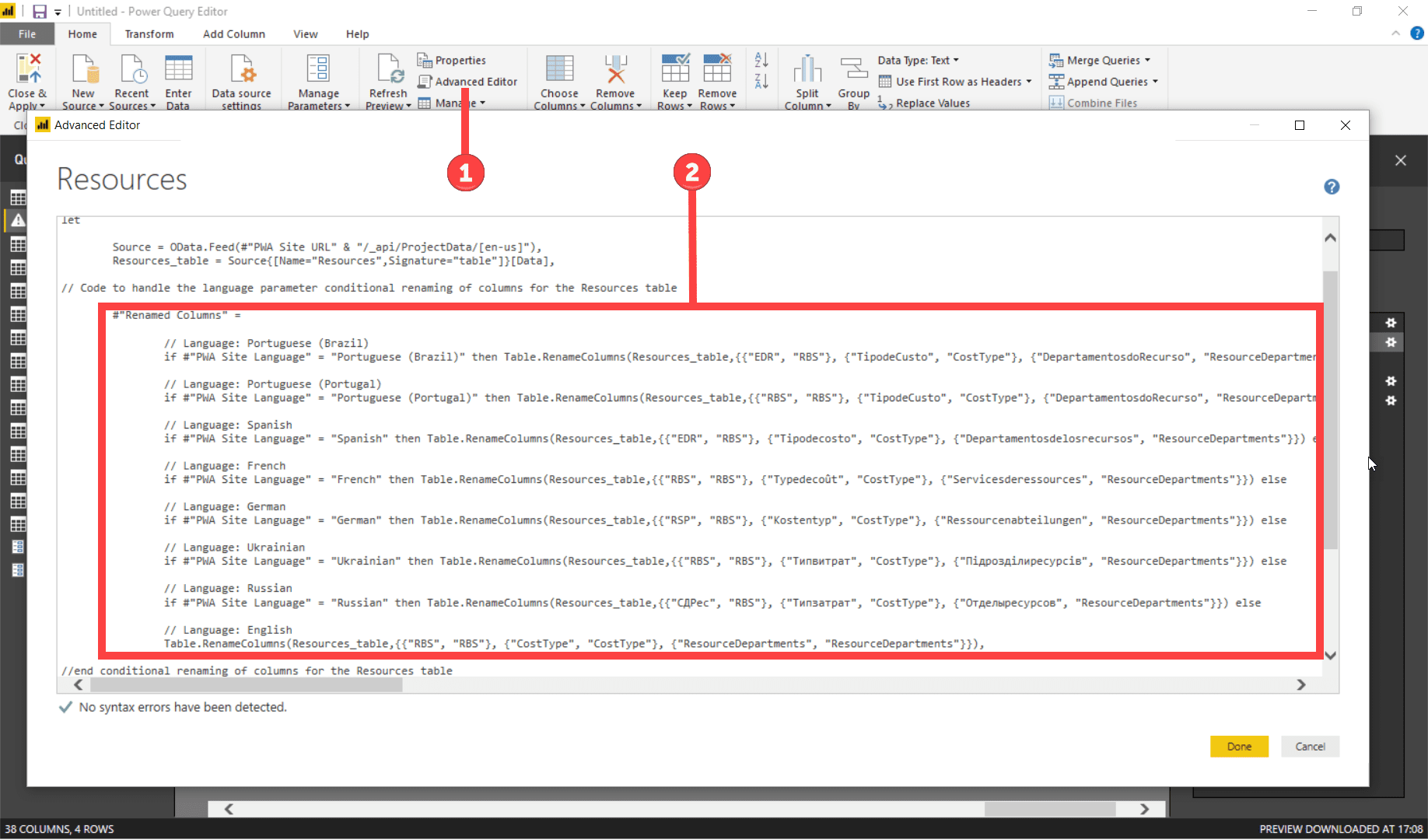

  2. Review the M-code within the editor and identify the portion that deals with the Language Selections (under the section called Renamed Columns).

The portion of the M-code that we are interested in is the one that renames the columns based upon the language choice (in our case Danish, even though we haven’t yet set up Power BI to be able to select this language). At this stage, you’ll need to copy and paste all the M-code into another editor (erm, notepad!) and save it before making any other changes.

Cut and paste one of the other language lines (e.g. Portuguese (Brazil), and change the references to match the language and translations. Note, I’ve highlighted them in bold below.

// Language: Danish

if #”PWA Site Language” = “Danish” then Table.RenameColumns(Resources_table,{ {“Omkostningstype“, “CostType”}, {“Ressourceafdelinger“, “ResourceDepartments”}}) else

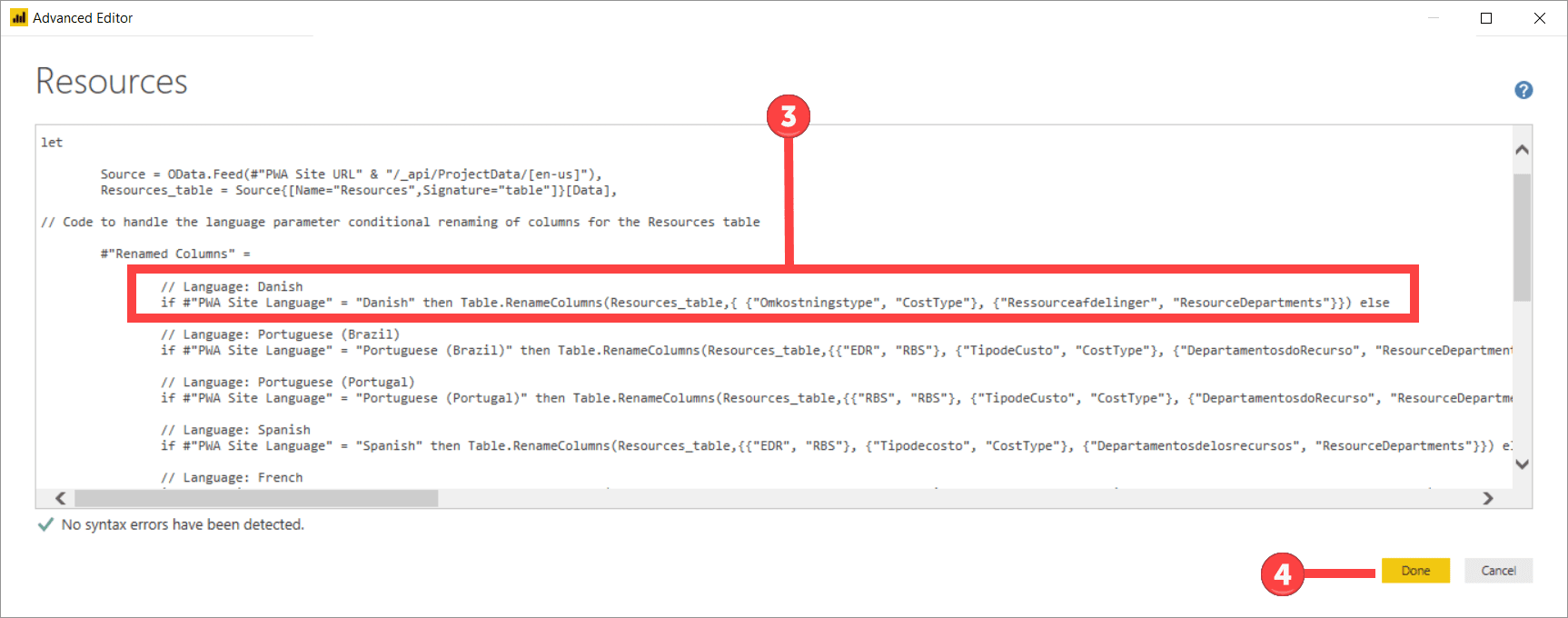

  1. Paste the modified code back into the Advanced Editor.
  2. Click Done to close the editor.

Add the New Language to the Language Parameter List

To test, we need to be able to choose the Danish language, and so this needs to be inserted as one of the options within the Language Parameter.

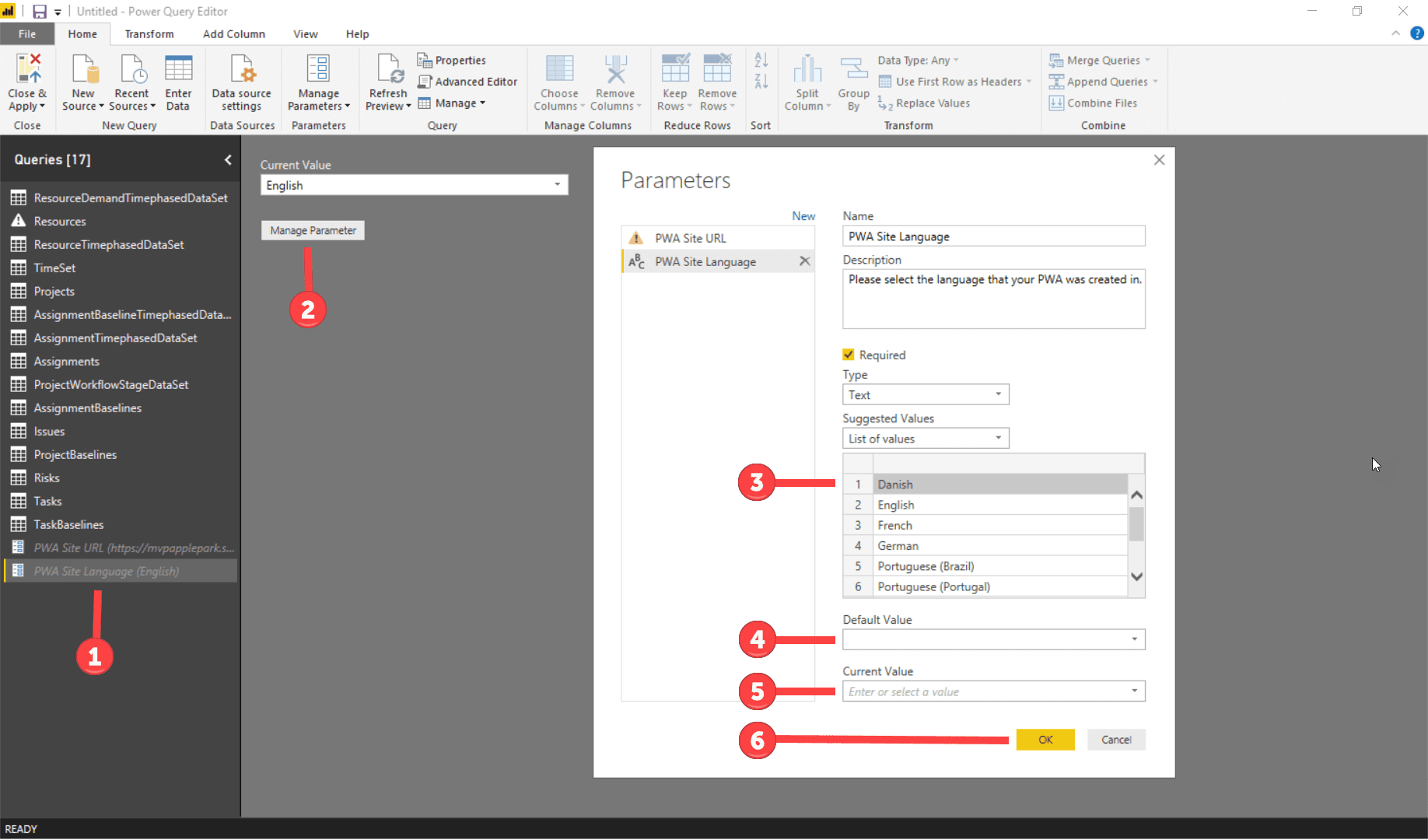

  1. Select the PWA Site Language parameter.
  2. Select the Manage Parameter button.
  3. Within the dialog box, enter the language name (“Danish”). Note, this must match the language name you entered into the Advanced Editor. You can cut and paste multiple parameters here, which is useful if you (like me!) want to display the language selection in alphabetical order.
  4. Choose a default value if you wish.
  5. Select your language (Danish) as the current value.
  6. Click OK.

Refresh the Resources Query

Now you need to refresh the query, to test both the language parameter and your M-code. If all goes well, the Resource Query will run with no errors.

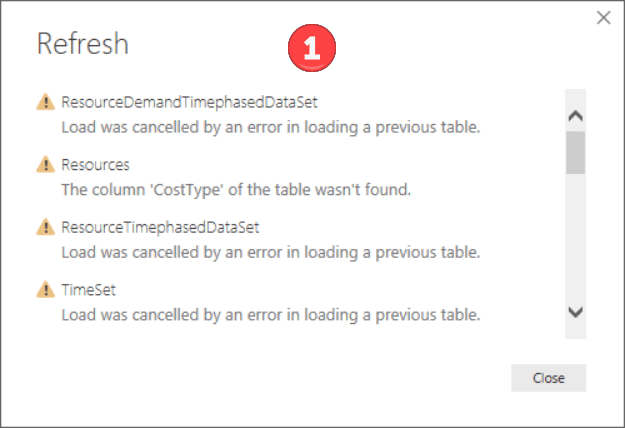

Click on the on the Refresh Query button to refresh the Resources query (see #1 below).

Iterate Through the Remaining Queries

It is then a question of iterating the process for each of the other queries until you don’t get any errors. I’ve listed the queries and fields I needed to update to get the Content Pack to work with my Danish PWA instance.

Query English Danish
Resources CostType Omkostningstype
ResourceDepartments Ressourceafdelinger
Projects ProjectDepartments Projektafdelinger
Assignments ResourceDepartments_R Ressourceafdelinger_S
RBS_R RBS_S
CostType_R Omkostningstype_S
Health_T Sundhed_N
FlagStatus_T Statusforflag_N

Once that’s done, it’s a simple case of selecting the applying within the Query Editor.

  1. Select the Close and Apply button within the Query Editor.

  1. The Power BI report will refresh, this time without any errors, and you’ll be able to use the content pack to review your Project Online data.

Save the Content Pack as a Template for Future Use

One final thing to note! If you want to re-use this pack, it’s worth saving it as a Power BI Template file, by using the File | Export button.

  1. Select the File button.
  2. Click on the Export tab.

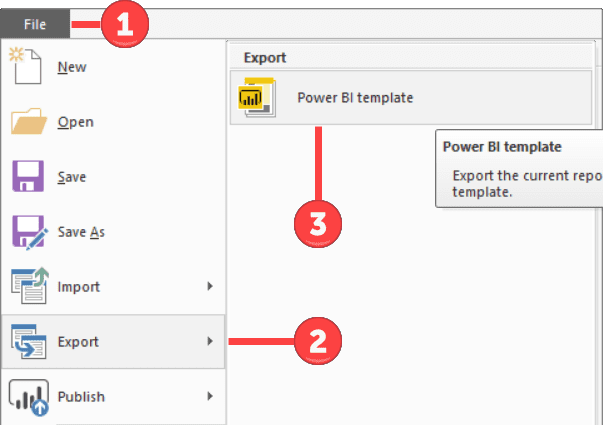

  3. Click on the Power BI Template option.

Open the Template to Test

Once you’ve saved it as a Template file, you will be prompted for the URL and Language when you next open it in Power BI. As you can see, we’ve now got Danish as an option.

  1. Enter the PWA URL.
  2. Choose the Language.
  3. Click Load.

Summary

As you can see, Power BI is an extremely powerful tool when it comes to reporting, especially when you use the Query Editor to manipulate the base data. With a little effort and determination, you can utilise the Power BI content pack against any of the supported languages for PWA, and of course, you can extend the content pack to your heart’s content!

If you would like to read up further on this or any other topic, please review the following links.

MPUG – mpugwp.wpengine.com

Blogs on Project – www.applepark.co.uk/ben-howard-blog

Technet Downloads – https://gallery.technet.microsoft.com/site/search?f%5B0%5D.Type=User&f%5B0%5D.Value=ben%20%20howard%20%5Bmvp%5D

Twitter – @ben_project

Related Content

Webinars (watch for free now!):
Updating Projects Progress with Microsoft Project
Understanding the Microsoft PPM Public Power BI Content Pack
Articles:
Beyond the 2017 PMI® PMO Symposium®: Inspiration from the Postal Service
Five Tips for Building your Organization’s Methodology
Using Local Calendars in the PPM Platform

Get Weekly PM Insights

Join 50,000+ PMs receiving updates on the latest PM methodologies, PDU opportunities, tool reviews, career tips, and member exclusives.

Protected by reCAPTCHA: Privacy & Terms

PMI ATP
PMI Authorized Training Partner
REP #4082

Learning Paths

PMP® TrainingCAPM® TrainingPgMP® TrainingPMI-ACP® TrainingMS ProjectMS PlannerMS TeamsJira

PM Resources

PDU TrackerLive WebinarsSalary CalculatorTool ComparisonsJob BoardKnowledge BasePM GlossaryOur Faculty

Community

Discussion ForumStudy GroupsEvents Calendar

Follow Us

LinkedInYouTubeTwitterFacebook
MPUGMaster Project User Group

© 2026 MPUG. All rights reserved.

TermsPrivacySitemapAdvertise
Articles

Modifying Microsoft’s Project Online Power BI Content Pack to Support Your Language

Content Pack Overview If you are using Project Online (PJO) then you are probably using the OData feed for reporting purposes, the two most common options being to bring the […]

7 min read
•over 8 years ago•Updated 10 months ago•
B
Ben HowardAuthor
Project Management
Microsoft Project
Best Practices
Productivity
B
Ben Howard

Content Writer

Ben Howard – Awarded Community Leader for his very popular and comprehensive UK web training series and has over 30 years of experience of implementing enterprise solutions for customers worldwide.  During that time, he’s worked for IBM, DELL, and Microsoft, as well as several smaller organisations. He now runs his own consultancy (Applepark Ltd), providing Project, Project Online and Power BI implementation and training services. He has been awarded the Microsoft Most Value Professional award for Project for the last 13 years, blogs semi-frequently at www.applepark.co.uk, produces video training for Pluralsight and his own YouTube channel, and finally was responsible for producing P2O, an application that exports tasks from Microsoft Project into Outlook.  You can catch him at ben@applepark.co.uk

View all articles by Ben Howard
Related Content

Continue Reading

Discover more insights and articles that complement your current reading

Collaboration challenges in remote projects (and how to fix each one)
Articles
1 min read

Collaboration challenges in remote projects (and how to fix each one)

Discover 5 common remote project collaboration challenges, from knowledge silos to unclear ownership, and learn practical ways to keep teams aligned and work moving.

A
Anonymous
8 days ago
Read
An Introduction to the PMI Practice Standard for Scheduling Conformance Index
Articles
1 min read

An Introduction to the PMI Practice Standard for Scheduling Conformance Index

Learn how the Conformance Index in PMI’s Practice Standard for Scheduling scores a CPM schedule model, and how to assess its components in any scheduling tool.

A
Anonymous
20 days ago
Read
A PM’s Halloween Survival Guide: The Sequel You Didn’t Want but Definitely Need
Articles
1 min read

A PM’s Halloween Survival Guide: The Sequel You Didn’t Want but Definitely Need

Part II of the PM Halloween survival guide takes on shape-shifting requirements and dependencies that won’t stay resolved, with practical defenses for each.

A
Anonymous
about 1 month ago
Read
Explore All Articles
