Background Information

Many years ago, I was working with a client located in downtown Denver, Colorado. I was teaching the project managers in the client’s PMO how to use the new version of Microsoft Project, which was the 2000 version at that time. In that version of the software, Microsoft introduced a new feature known as Deadline dates, which can be used to set a “target date” for the completion of any task. I taught my first class of students how to properly use Microsoft Project 2000 to manage their projects, including how to use the new Deadline dates feature.

When I returned a couple of weeks later to teach the second group of project managers for this client, I learned that their PMO leadership had developed a methodology for using the new Deadline dates feature. Their process was for the project manager to do the following after completely planning a new project:

  • Negotiate with the internal client to determine the target completion date for each phase of the project and for the project as a whole.
  • Based on the agreed-upon target dates, specify a Deadline date on the final milestone for each phase of the project and on the final Project Complete milestone as well.

By the way, I was incredibly pleased that my client had taken what I had taught them about the Deadline dates feature, and then extended that knowledge into their own unique methodology for using this feature! In my experience, Deadline dates are an excellent way to set target dates for the completion of any type of task, including summary tasks, detailed tasks, and milestone tasks. I personally like to use a Deadline date for the final milestone task in each of my projects to specify when the project needs to be completed.

Creating a Deadline Date

If you have never used Deadline dates in your own projects, following is the process for setting a Deadline date on a task:

  1. Apply the Gantt Chart view and then double-click the name of the task on which you want to set a Deadline date.

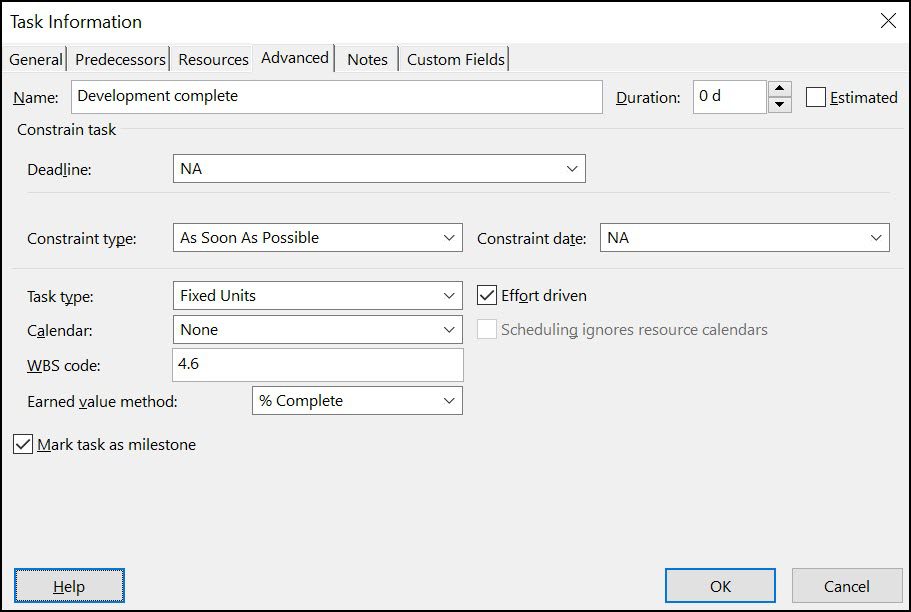

  2. In the Task Information dialog, click the Advanced tab, such as shown in Figure 1.

Figure 1: Task Information dialog, Advanced page

3. In the Task Information dialog, click the Deadline pick list, and select the date of the Deadline on the calendar date picker, such as shown in Figure 2.

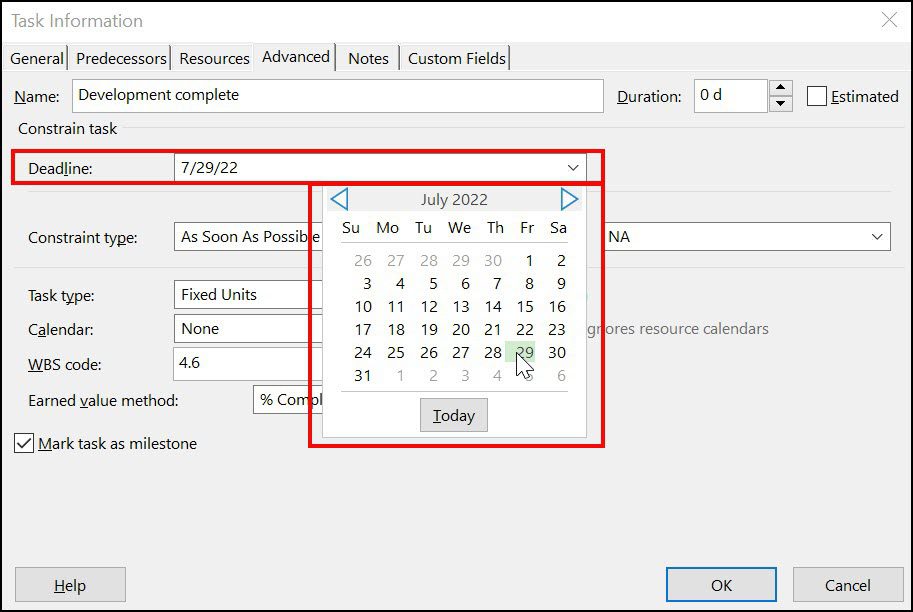

Figure 2: Select a date in the Deadline field

4. Click the OK button.

When you specify a Deadline date on a task, Microsoft Project displays a “downward pointing” light green arrow on that date in the Gantt Chart pane for that task. In Figure 3, for example, notice that I have specified a Deadline date on the milestones for the Development, Testing, and Pilot phases of the project, along with the final Project complete milestone task. Once you have specified Deadline dates on tasks in your project schedules, you can point out to all interested parties that those green arrows in the Gantt Chart represent the target completion dates for tasks in the project. Doing so on a regular basis helps everyone to remember the target dates for the completion of specific tasks in your project schedule.

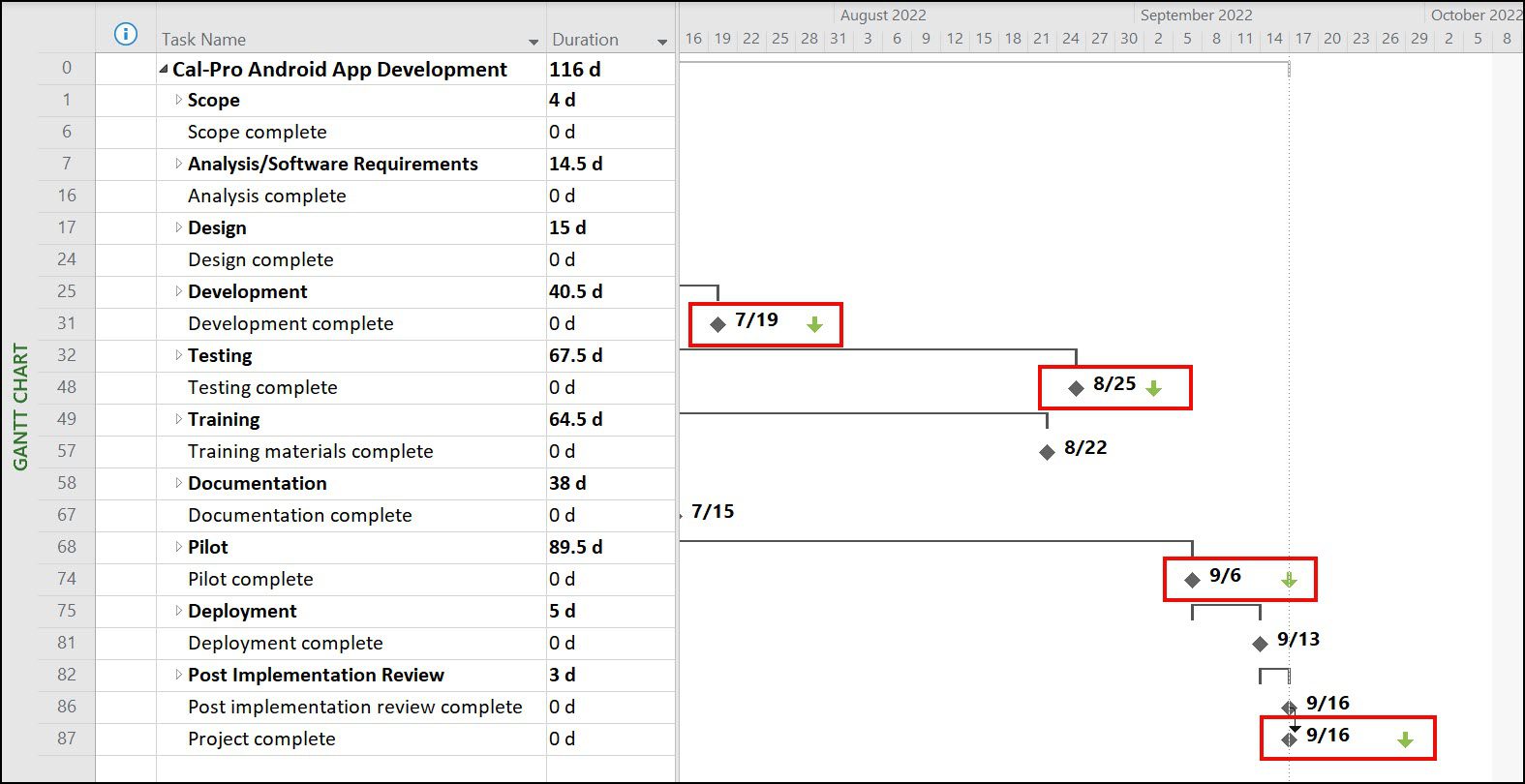

Figure 3: Deadline dates specified on four milestone tasks

Heads Up: In my next MPUG article, I will show you how to extend the functionality of Deadline dates by using a custom field to calculate the number of days between the Finish date of a task and its Deadline date. And I will even show you how to use graphical indicators in the custom field to make it very easy to see when the Finish date of a task is moving too close to its Deadline date.

Get Weekly PM Insights

Join 500,000+ PMs receiving updates on the latest PM methodologies, PDU opportunities, tool reviews, career tips, and member exclusives.

PMI ATP
PMI Authorized Training Partner
REP #4082

Learning Paths

PMP® TrainingCAPM® TrainingPgMP® TrainingPMI-ACP® TrainingMS ProjectMS PlannerMS TeamsJira

PM Resources

PDU TrackerLive WebinarsSalary CalculatorTool ComparisonsJob BoardKnowledge BasePM Glossary

Community

Discussion ForumStudy GroupsEvents Calendar

Follow Us

LinkedInYouTubeTwitterFacebook
MPUG Logo

© 2026 MPUG. All rights reserved.

TermsPrivacySitemap
Articles

Set a Target Date for Task Completion Using Deadline Dates

Background Information Many years ago, I was working with a client located in downtown Denver, Colorado. I was teaching the project managers in the client’s PMO how to use the […]

3 min read
•almost 4 years ago••
D
Dale HowardAuthor
Project Management
Microsoft Project
Best Practices
Productivity
D
Dale Howard

Content Writer

Dale Howard is currently a Senior PPM Consultant with Arch Systems, Inc. His hair and beard have turned white because of using Microsoft's project management tools for more than 20 years. Dale started his career using Microsoft Project 4.0 for Windows 95 and began using Microsoft's PPM tools when they introduced Project Central in 2000. Dale is the co-author of 23 books in Microsoft Project, Project Server, and Project Online. He is currently one 0f 26 Microsoft Project MVPs in the entire world and one of only 4 Project MVPs in the United states.

View all articles by Dale Howard
Related Content

Continue Reading

Discover more insights and articles that complement your current reading

Two Project Manager Agent Features You Might Like
Articles
5 min read

Two Project Manager Agent Features You Might Like

Discover two game-changing features of Microsoft’s Project Manager Agent including agent-to-agent communication and the new integrated interface in Planner.

E
Erik van Hurck
about 2 months ago
Read
Master Dependency Analysis in Microsoft Project with SSI Tools!
Articles
2 min read

Master Dependency Analysis in Microsoft Project with SSI Tools!

Learn how to master dependency analysis in Microsoft Project using SSI Tools’ Directional Path, Connecting Path, and Dependency Tracer to analyze predecessors, successors, and project logic.

K
Kenny Arnold
about 2 months ago
Read
A PM’s Halloween Survival Guide
Articles
5 min read

A PM’s Halloween Survival Guide

Discover the spooky parallels between Halloween and project management, from scope creep monsters to ghosted team members, in this fun survival guide for PMs.

R
Ronald B. Smith, MBA, PMP
3 months ago
Read
Explore All Articles
