Project Server 2010 allows for the option of auto-approving task status updates, and since SP1, this has become even more useful as the option to publish the update has been added.

However, due to the complexity of setting up the rules and lack of documentation regarding task status updates, PMs have either tended to not use them, or go for one of the easiest options of trusting all the updates from a select few employees (they either sit in the Trust no-one camp or I trust a few people, but not everyone camp).

Ive found this slightly limiting, and Ive recently been setting up a system for a client who wishes to manage these updates by exception only, rather than a blanket approval rule for a discrete set of employees. This client manages their plans by monitoring the completion dates of tasks (as oppose to the amount of work performed on a task).

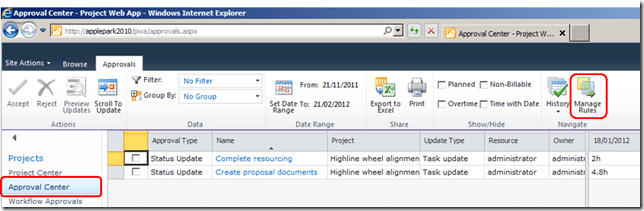

To set up this scenario we first need to open up PWA and navigate to the Approval Center. Next, click on the Manage Rules button on the Ribbon.

Automatically Approve Task Status Updates

The Manage Rules page appears, and in the Ribbon click on the New icon to create a new rule.

Give your rule an appropriate name and description (Note: For best practise I will ALWAYS add the rule I’m testing for in the Name, and then the full description in the Description section. When you have a lot of rules, it becomes much easier to decide which one to edit when they are named and described such).

Decide then whether to select the check boxes for Automatically Running the Rule and Automatically Publish the Updates (Note: For best practise I will turn these OFF (i.e., not selected) until I have verified that the rule does exactly what I want.Of course you will want to test these rules on a test project or -even better – a test system before moving them to production).

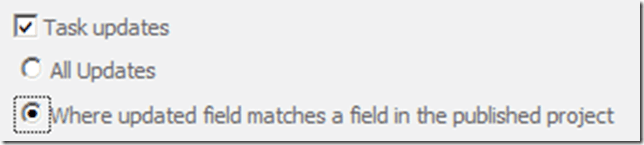

Select the request type. For this we need to check Task Updates, and then the radio button “Where updated field matches a field in the published project”.

Automatically Approve Task Status Updates

The trick now is to select the updated fields to test against. For our scenario, we want to perform the following test:

Automatically Approve Task Status Updates

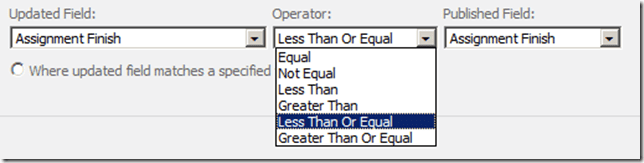

Assignment Finish <= Assignment Finish Note: We are testing the updated field against the published field.

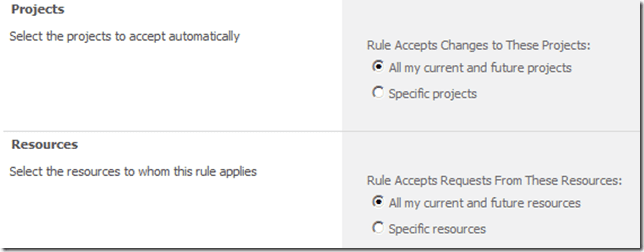

Once this is completed, it is possible to restrict both the projects and resources that this rule is run for. In our instance, it is left for all projects and all resources.

Automatically Approve Task Status Updates

Click on Save.

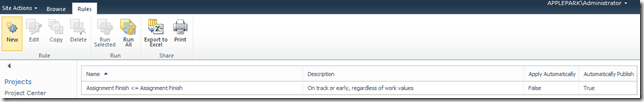

The rule now appears within the Manage Rules screen, and it can easily be seen what the rule does due to sensible naming and the description. (Note: There is no button on the Ribbon to go back to the Approval Center, so select the Approval Center from the links menu on the left-hand side.

Automatically Approve Task Status Updates

Test the rule by publishing a test project with several tasks and updating tasks via My Tasks. In order to get the Assignment Finish Date to change beyond the Published Finish Date, you’ll need to update the work values so that they extend beyond the planned work values. You can either do this by changing the start date to to one after the planned start date, or if you are typing in Timephased values (either by tracking time per day or using Single Entry Mode), you will need to enter less work on the planned start date, or any of the planned work dates. This should cause the scheduling engine to move the Assignment Finish Date out into the future, and hence the rule wont trigger. You will also want to test for tasks that are on-track (just update the % complete) and tasks that are early, so that the rule will trigger.

Once the updates have been sent to the Status Manager, open up the Approval Center, navigate to the Manage Rules section, and click on the Run All button. The rule should run automatically and can be checked via the History button. When the rule is firing correctly, you can change the rule to Run Automatically.

Rules needs to be set up for each PM individually, and alas, there is no way to combine tests across rules. Ideally I would like to have some logical operators (AND, OR) in order to approve an update (e.g., IF (condition X AND condition Y) OR condition Z) is met then approve the update).

However, it is what it is, and used sensibly it can save time for a PM, allowing them to concentrate on the exceptions, which should be fewer in number, though not in complexity.

Enjoy, Ben.

Get Weekly PM Insights

Join 50,000+ PMs receiving updates on the latest PM methodologies, PDU opportunities, tool reviews, career tips, and member exclusives.

Protected by reCAPTCHA: Privacy & Terms

PMI ATP
PMI Authorized Training Partner
REP #4082

Learning Paths

PMP® TrainingCAPM® TrainingPgMP® TrainingPMI-ACP® TrainingMS ProjectMS PlannerMS TeamsJira

PM Resources

PDU TrackerLive WebinarsSalary CalculatorTool ComparisonsJob BoardKnowledge BasePM GlossaryOur Faculty

Community

Discussion ForumStudy GroupsEvents Calendar

Follow Us

LinkedInYouTubeTwitterFacebook
MPUGMaster Project User Group

© 2026 MPUG. All rights reserved.

TermsPrivacySitemapAdvertise
Articles

Automatically Approve Task Status Updates

Project Server 2010 allows for the option of auto-approving task status updates, and since SP1, this has become even more useful as the option to publish the update has been […]

4 min read
•almost 14 years ago•Updated 10 months ago•
B
Ben HowardAuthor
Project Management
Microsoft Project
Best Practices
Productivity
B
Ben Howard

Content Writer

Ben Howard – Awarded Community Leader for his very popular and comprehensive UK web training series and has over 30 years of experience of implementing enterprise solutions for customers worldwide.  During that time, he’s worked for IBM, DELL, and Microsoft, as well as several smaller organisations. He now runs his own consultancy (Applepark Ltd), providing Project, Project Online and Power BI implementation and training services. He has been awarded the Microsoft Most Value Professional award for Project for the last 13 years, blogs semi-frequently at www.applepark.co.uk, produces video training for Pluralsight and his own YouTube channel, and finally was responsible for producing P2O, an application that exports tasks from Microsoft Project into Outlook.  You can catch him at ben@applepark.co.uk

View all articles by Ben Howard
Related Content

Continue Reading

Discover more insights and articles that complement your current reading

An Introduction to the PMI Practice Standard for Scheduling Conformance Index
Articles
1 min read

An Introduction to the PMI Practice Standard for Scheduling Conformance Index

Learn how the Conformance Index in PMI’s Practice Standard for Scheduling scores a CPM schedule model, and how to assess its components in any scheduling tool.

A
Anonymous
3 days ago
Read
A PM’s Halloween Survival Guide: The Sequel You Didn’t Want but Definitely Need
Articles
1 min read

A PM’s Halloween Survival Guide: The Sequel You Didn’t Want but Definitely Need

Part II of the PM Halloween survival guide takes on shape-shifting requirements and dependencies that won’t stay resolved, with practical defenses for each.

A
Anonymous
21 days ago
Read
Context Engineering for Project Managers: Give AI the Project, Not Just the Question
Articles
1 min read

Context Engineering for Project Managers: Give AI the Project, Not Just the Question

Learn how to choose, date, and source the project information you give AI, so its risk analyses, status reports, and change request reviews reflect your actual project.

A
Anonymous
about 1 month ago
Read
Explore All Articles
