2 Ways to Manage Resource Availability in Microsoft Project

When starting to plan the development of a new project, one important task for the project manager is to identify the roles and responsibilities required to deliver the project based upon the agreed scope. You also will need to have a clear understanding of the availability of the resources that play roles throughout the project lifecycle.

So it’s frustrating to discover during the execution of the project that a key member of the team isn’t available in the next week due to vacation — which was already planned more than six months ago. To avoid problems with the resources not being available to perform the tasks under their care, it’s important to manage information about resource availability, a job that can be handled in Microsoft Project.

Options to Manage Resources Availability

You have two options to manage resource availability in Project:

  • Change their units (availability); or
  • Change their working time (calendar).

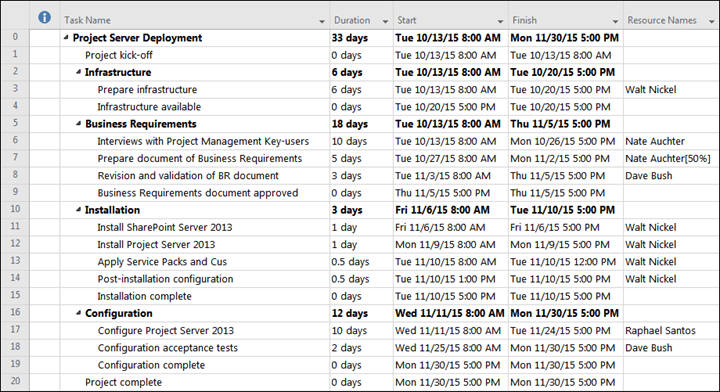

We’ll use the example presented in the schedule below to make simulations and discuss the pros and cons for each option.

Raphael_Santos_Options-to-Manage-Resources-Availability_figure_1

Changing the Resource’s Availability

When you change the availability of a resource in Microsoft Project, you are basically telling the software that during a specific period that person’s availability will be reduced. When making this change, it’s possible to identify the tasks assigned to this resource during the period of his or her unavailability because they’ll be marked with the “over-allocated” indicator.

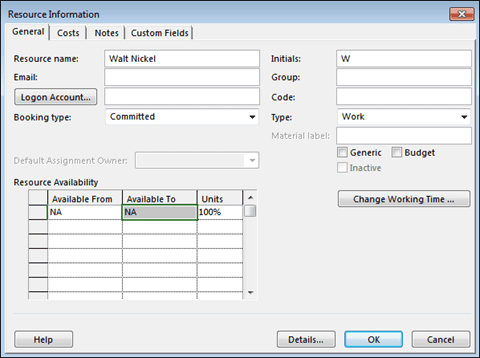

Let’s say that you have been informed that the resource Walt Nickel will be on vacation from 11/02/2015 to 11/13/2015. Based on that information, you need to “inform” Project of Walt’s unavailability. Navigate to the Resource Sheet view. Then double-click the resource Walt Nickel to display the Resource Information dialog.

Raphael_Santos_Options-to-Manage-Resources-Availability_figure_2

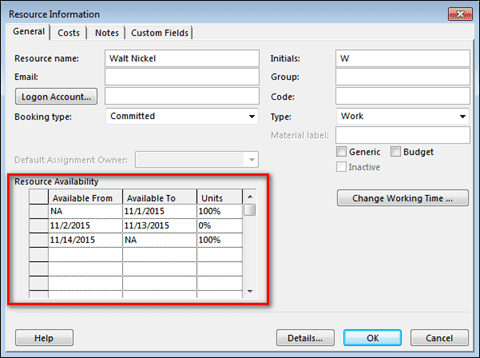

Look at the Resource Availability area. There you can configure the periods in which Walt isn’t available or in which his availability will be reduced. Change his availability as follows:

In the Available To field on the first line, type 11/01/2015, which is the last date for which Walt will have 100 percent of availability prior to his vacation.

On the second line, in the Available From field, type 11/02/2015, which is the starting date of his vacation. Then, in the Available To field, type 11/13/2015, which is the date Walt’s vacation ends. After that, in the Units field, type 0% to make Walt unavailable for this period.

On the third line, in the Available From field, type 11/14/2015, which is the date Walt will be fully available to work in the project again. In the Units field, type 100%.

Raphael_Santos_Options-to-Manage-Resources-Availability_figure_3

Click OK.

You will instantly see that Project indicates that Walt is over-allocated, as the period of his vacation conflicts with some tasks that have been assigned to him:

Raphael_Santos_Options-to-Manage-Resources-Availability_figure_4

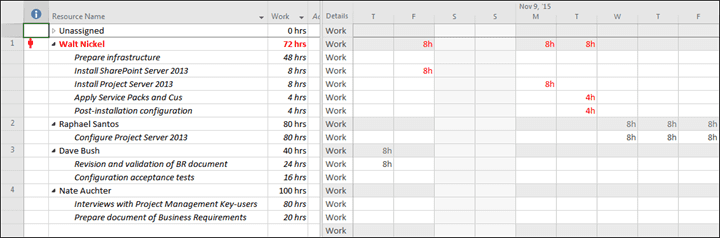

There are many different ways you can see over-allocated resources in Project. In this example I switch to the “Resource Usage” view to see the tasks that were affected by Walt’s unavailability:

Raphael_Santos_Options-to-Manage-Resources-Availability_figure_5

You can also view the over-allocation using the Team Planner or Resource Graph views, or through Project’s reports.

The positive side of changing the resource’s availability is that by understanding when and where the resource is unavailable, you can take proactive actions to reorganize the schedule (for example, reassigning tasks to other resources when possible), in order to reduce the impact in the project. On the other hand, you’ll also have to take care of the corrective actions manually; for big schedules this can be challenging.

Changing the Working Time

The second option for changing the resource’s availability is to configure the person’s working time. This option allows you to set restrictions to a resource’s calendar, creating nonworking time for a specific period. When using this approach, instead of informing you that the resource is over-allocated, Project will move the tasks along and assign them to the next date when the resource is available to work.

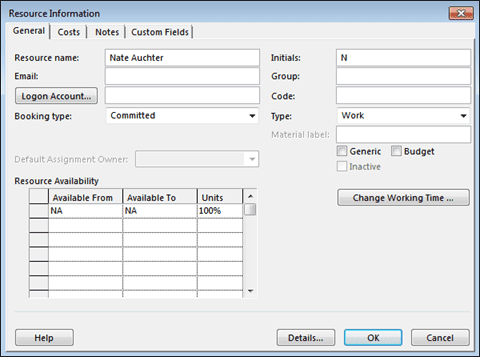

For example, let’s say you’ve been informed that the resource Nate Auchter will be on vacation from 10/13/2015 to 10/16/2015. Based on that, you need to tell Project of Nate’s unavailability. Navigate to the Resource Sheet view. Then, double-click the resource Nate Auchter to see the Resource Information dialog.

Raphael_Santos_Options-to-Manage-Resources-Availability_figure_6

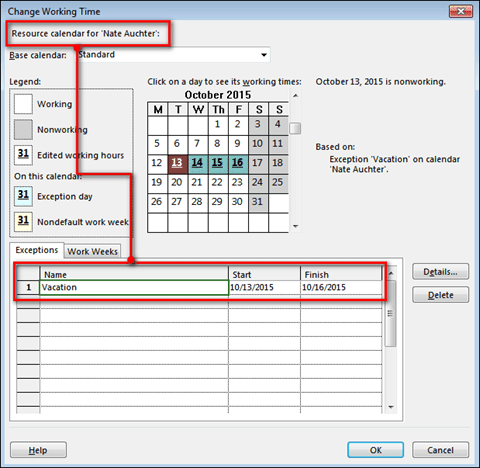

However, instead of changing Nate’s availability, let’s change his working time. Click the Change Working Time button. In the Change Working Time dialog, create an exception to Nate based on his vacation, as follows:

Raphael_Santos_Options-to-Manage-Resources-Availability_figure_7

Click OK and OK.

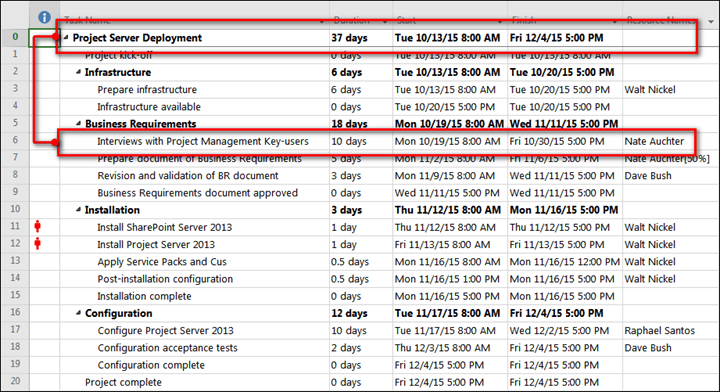

You won’t see any signal of over-allocation for Nate. However, notice that a task assigned to him, “Interviews with Project Managers and key users” was changed automatically by Project, due to Nate’s unavailability. The task was previously scheduled from 10/13/2015 to 10/26/2015, and now it is scheduled from 10/19/2015 to 10/30/2015. Consequently, the schedule, which was planned originally to finish at 11/30/2015, is now finishing at 12/04/2015:

Raphael_Santos_Options-to-Manage-Resources-Availability_figure_8

The positive side of changing the resource’s working time using this method is that Project will make the changes to reorganize the tasks automatically based upon the resource’s availability. However, sometimes it can be hard to understand where the changes have been made and how they impact the schedule.

Now that you know the two available options to control your resources availability, it’s up to you to decide which one best meets your needs.

Have another approach for handling resource availability? Share your ideas with the MPUG community in the comments below.

A version of this article first appeared on the Sensei Project Solutions blog.

[ezcol_1third]

FREE MPUG Resources

[/ezcol_1third]

[ezcol_1third]

Microsoft Project Resources

[/ezcol_1third]

[ezcol_1third_end]

Additional Resources

[/ezcol_1third_end]

Written by Raphael Santos
Raphael Santos is a PPM enthusiast with expertise in providing Microsoft Project, Project Online, and Project Server solutions. He has worked in several projects to implement PPM tools, including projects located in Latin America (Brazil, Peru, and Argentina), in the United States, and in Africa. He is also a trainer with more than 10 years of experience teaching users how to use Project Management tools in a more productive way. In 2016, Raphael was awarded the MVP title by Microsoft in recognition of his contributions to the Project Management community. Raphael is a PPM Consultant at Sensei Project Solutions, a certified Microsoft partner specializing in project and portfolio management deployments. Sensei offers a complete set of services to help organizations succeed with their Microsoft PPM deployments. Services include full implementation and training as well as pre-configured solutions and report packs. Visit senseiprojectsolutions.com or contact info@senseiprojectsolutions.com for more information.
Share This Post
Have your say!
00
6 Comments
  1. Very helpful article. The first approach is very creative.

  2. Hi Shirin —

    Thank you for your comment.

    Raphael

  3. Thanks Raphael. Nice article. Here is another approach. I like the “Change Working Time” option. Here’s why. The auto-scheduling of “missed days” make the replanning easier. If you need more visibility of resources with non-working days, try this. From the Gantt Chart View, right Click. Pick the “Non-Work Time…” option. Then from choices, select Highlight Color, Pattern, and most important, Resource Calendar of your target. Bang! You have a nice visual of days this resource is off work.

  4. Hello Chris —

    That’s an awesome addition to the article. Thanks for sharing this 🙂

  5. Hi Viplav,

    Material and Cost resource do not have availability, only Work resources.

    I hope this helps.

  6. I could have sworn that absences for ANY reason would not automatically reschedule the task. The reason being is that by auto rescheduling, Project doesn’t allow the PM to recognize the overallocation and choose a different option such as leave the task as is and reassign it. Did something in Project recently change this logic?
