What is a Baseline?

Athletes on Starting Line

A baseline, as traditionally defined, is a value or condition against which future measurements can be compared. Within the context of project management, these values and conditions are the project’s scope, cost and schedule. A project baseline can be thought of as a “snapshot” of a project’s initial condition, just before work begins.

Baselines are used to evaluate project performance over time, by comparing an initial project snapshot with any subsequent images captured while your project progresses. Baselines are also used to quantify any variances from the original plan while the plan is in motion.

You can also think of a project baseline as a “sanity check,” in the sense that project sanity is defined as not making the same mistake over and over again while hoping for a better result!

Once your project is designed, capturing an initial project baseline is the first step taken to ensure better project performance — and PM sanity – over time. The baseline draws a line in the sand that says, “This is what we thought was going to happen, vs. what actually happened.”

Using Microsoft Project for Project Baselines

Most decent project management tools have a feature for capturing the initial baseline and displaying any variances from that initial line in the sand. Microsoft Project is no exception. It can store and display up to 10 baselines for any given project or for a select group of tasks. The typical baseline metrics most project managers use are: baseline duration, work and cost. However, many other metrics can be defined and then displayed.

When using Microsoft Project, it is important to remember to set the initial baseline before putting the schedule into play. In other words, this step needs to be taken before work begins, but after you have designed your project plan and you are ready to roll.

Note: Forgetting to set an initial baseline is a common mistake most new users of Microsoft Project make, and this boo-boo can’t easily be corrected once your plan is in motion and being tracked.

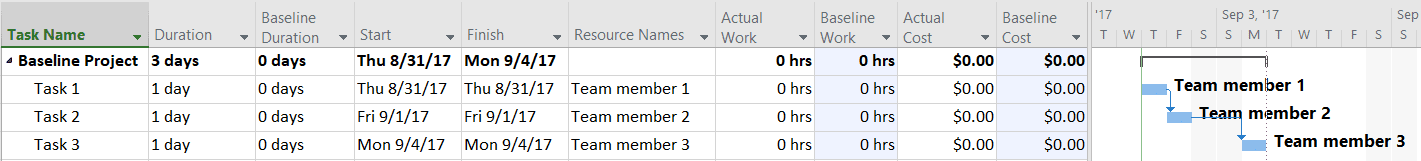

To visualize how a baseline is used within Microsoft Project, let’s take this simple three-day, three-task, three-person project as an example, before the initial baseline has been set:

Gantt chart view of a project designed, but with no baseline set
Gantt chart view of a project designed, but with no baseline set

(To work with the example referenced in the article, download Baselines.mpp here.)

Setting a Project Baseline in MS Project

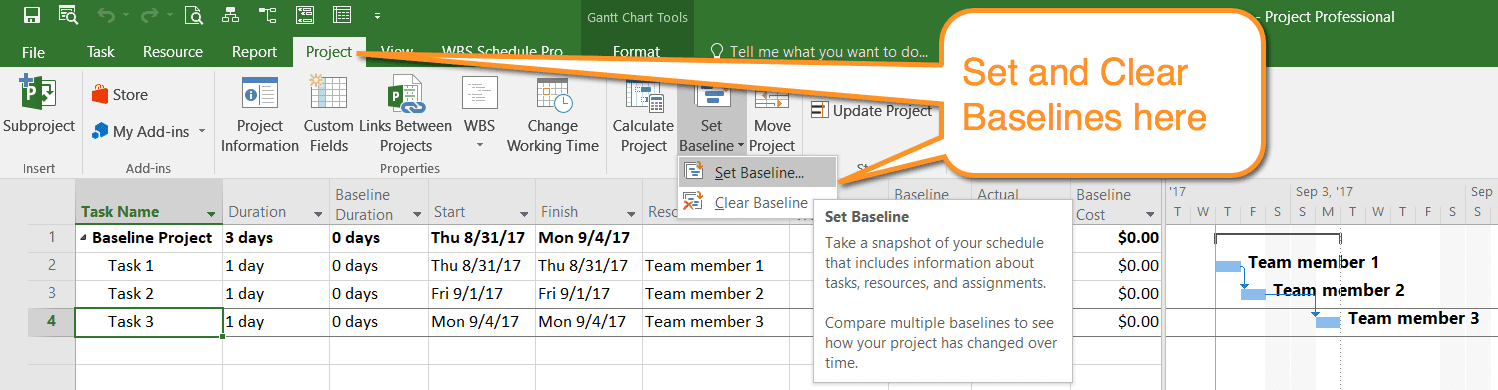

Baselines are set in Microsoft Project using the Project ribbon / Set Baseline click:

Setting and clearing baselines in Microsoft Project Professional
Setting and clearing baselines in Microsoft Project Professional

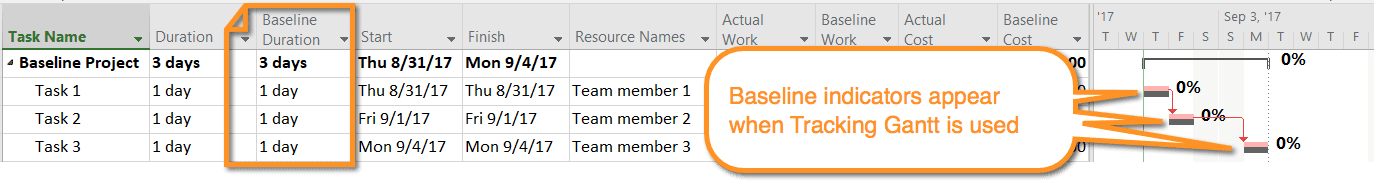

Once you have set an initial baseline, Microsoft Project begins crunching the numbers and updating baseline values in fields and on the Tracking Gantt chart as each change is made:

With a baseline set, the calculations begin!
With a baseline set, the calculations begin!

Baseline Shifts

Now with a baseline set, the fun begins as Microsoft Project begins tracking and displaying changes made to your plan. Let’s assume that our three-day, three-task, the three-person project was completed, but with Team member 1 — being the slowpoke that he is — taking two days to complete the one-day task as planned.

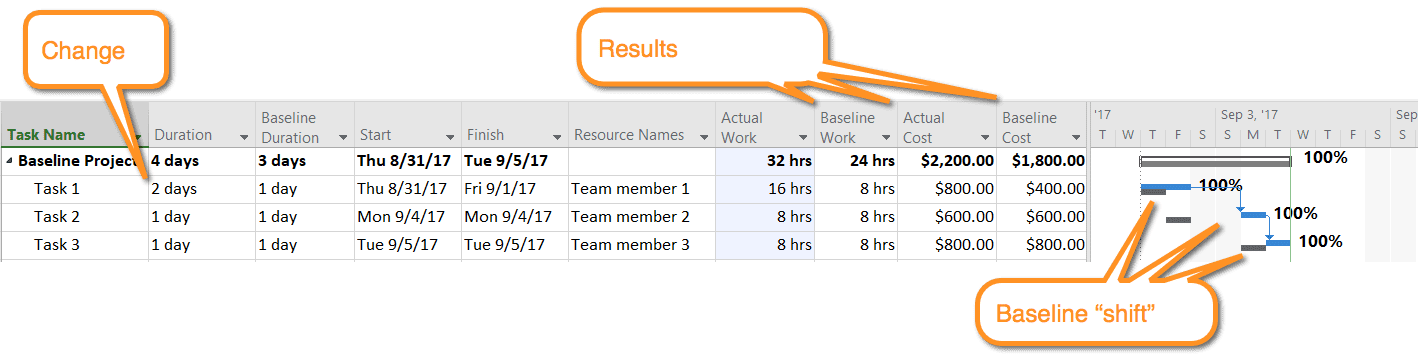

The resulting display in our project plan now shows this variance, using actual values and baseline values and displaying a baseline “shift” in the Tracking Gantt chart:

Variances from a baseline are shown in baseline fields and on the Tracking Gantt chart
Variances from a baseline are shown in baseline fields and on the Tracking Gantt chart

Baseline shifts are an important indicator of project performance over time and should be employed by every project manager when evaluating project metrics.

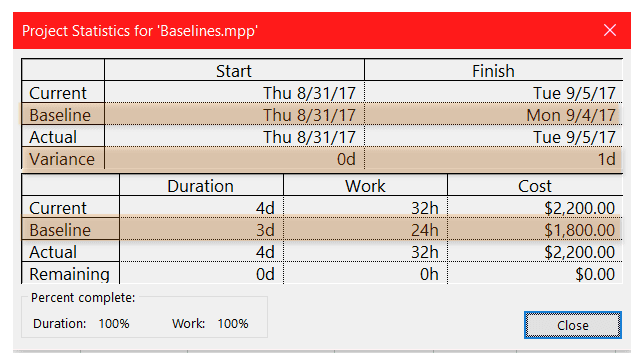

Quick Tip: Another quick way of seeing these shifts in your plan, is to use the Project ribbon to view Project Information / Project Statistics, which are updated in real-time, as shown in the figure below:

Project Statistics shows basic baseline values and variances
Project Statistics shows basic baseline values and variances

For more detailed information on using baselines within Microsoft Project, read this MPUG article: “5 Things to Know about Microsoft Project Baselines.”

Written by Jigs Gaton
Jigs Gaton is CEO of Phoenix Consulting and Training Worldwide, a company that helps developers design and implement better programs and build capacity with training and other resources. Jigs has over 30-plus years of experience in both the private and public sectors working as a project manager and PM consultant. He's currently based in Kathmandu, helping organizations with post-earthquake reconstruction and other disaster-relief efforts.
