Background Information

I answered a question recently in the Tech Community Project user forum about how to edit an existing enterprise template in Project Online. That user’s question, and the answer I provided, got me thinking about the process needed to update an existing project template. I began exploring how to update an existing project template in both the Microsoft Project desktop application and in Microsoft Project Professional when used with either Project Online or Microsoft Project Server. In my process of exploration, I discovered that a common method is needed to update an existing template with either tool.

Suppose that you need to make changes to an existing project template. For example, you might need to add a new section of tasks in the template, to change task dependency relationships or task Duration values, or to add a standard set of team members to the project.

If you ever run into situations like this, you need to be aware that there is no method that allows you to directly edit a project template and then save those changes to the template. But there is an indirect method that you can use to edit the project template and then to save the changes.

In this blog post article, I am making the following assumptions:

  • If you are a user of the Microsoft Project desktop application, you have saved at least one project template on your PC.
  • If you are a user of Microsoft Project Professional with either Project Online or Microsoft Project Server, a responsible person in your organization has saved at least one enterprise project template, and you have permission in the system to edit enterprise templates.

Based on the preceding assumptions, in this blog post article I will teach you the secret, non-obvious method for editing an existing project template.

Solution for Users of the Microsoft Project Desktop Application

Complete the following steps to edit and save any existing project template:

  1. Launch Microsoft Project.

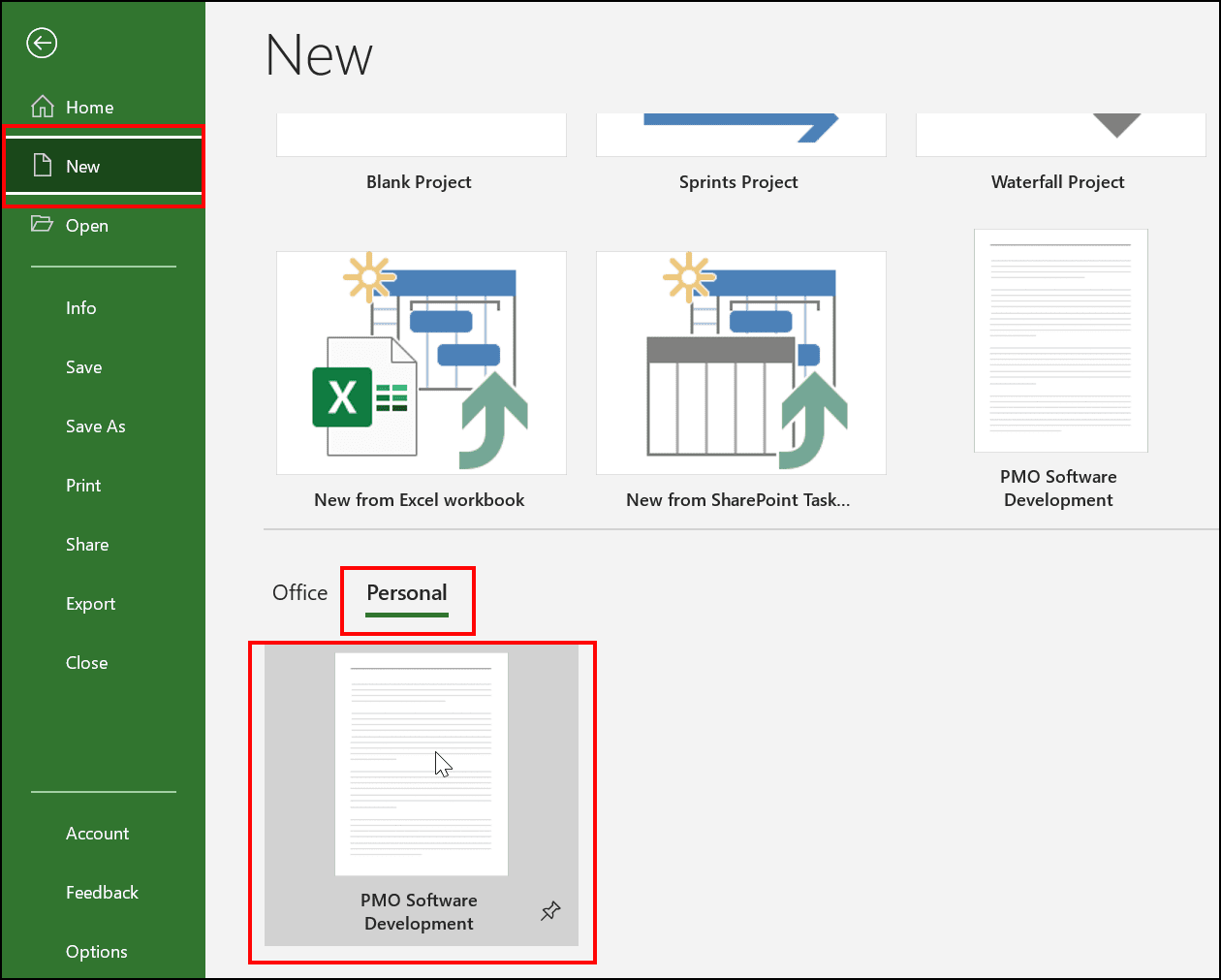

  2. Click the File tab, click the New tab in the Backstage, and then click the Personal tab. Click the name of the template which you want to update and then create a new project from this template. For example, notice in Figure 1 that I am creating a new project from the PMO Software Development template.

Figure 1: Create a new project from an existing template

3. In the preview dialog, such as the one shown in Figure 2, click the Create

Figure 2: Preview dialog to create a new project from a template

4. Edit the project with any changes you want to see reflected in the updated project template. For example, you might need to add a new set of tasks to the template.

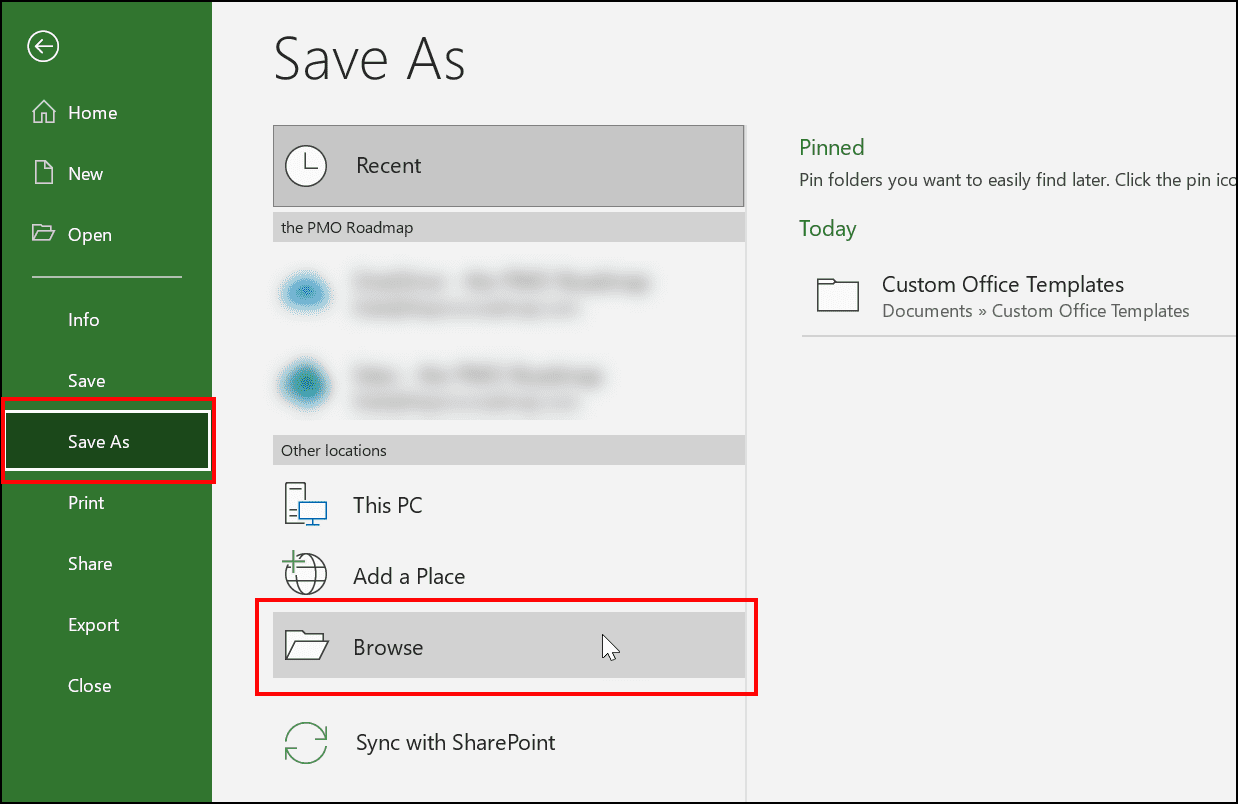

5. Click the File tab and then click the Save As tab in the Backstage. Click the Browse button in the lower left corner of the Backstage, such as shown in Figure 3.

Figure 3: Save As page in the Backstage

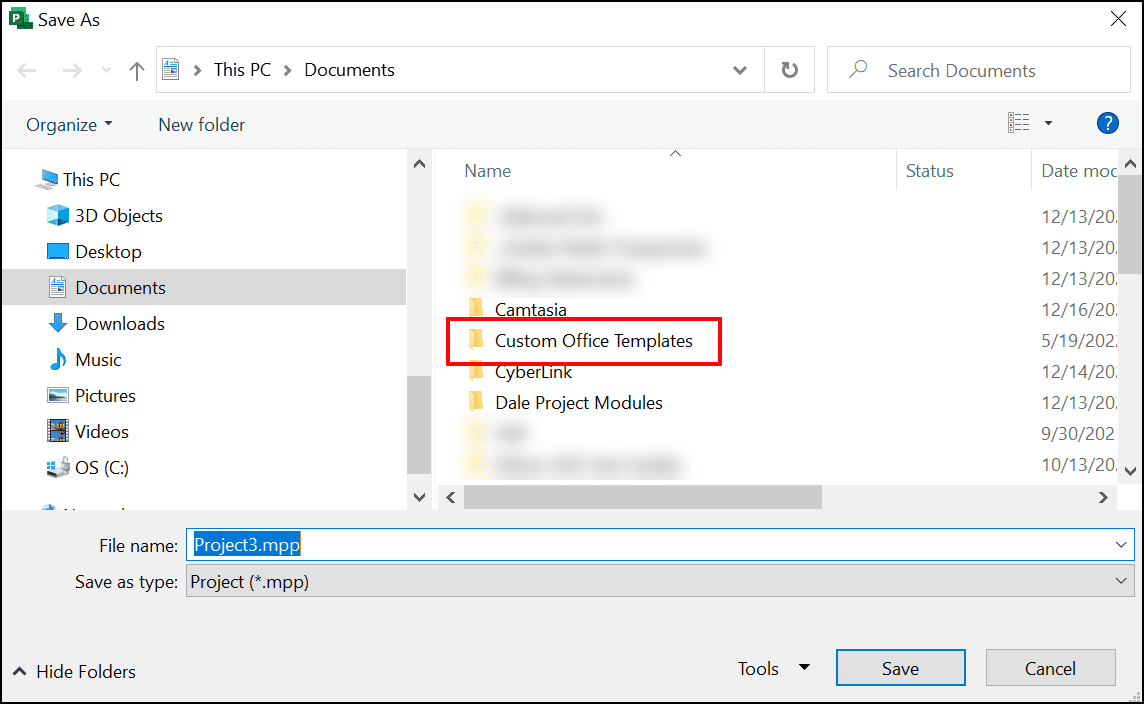

6. In the Save As dialog, navigate to the folder in which you saved your project template. For example, notice in Figure 4 that I save all of my Microsoft Office templates in the Custom Office Templates subfolder of the Documents folder.

Figure 4: Save As dialog

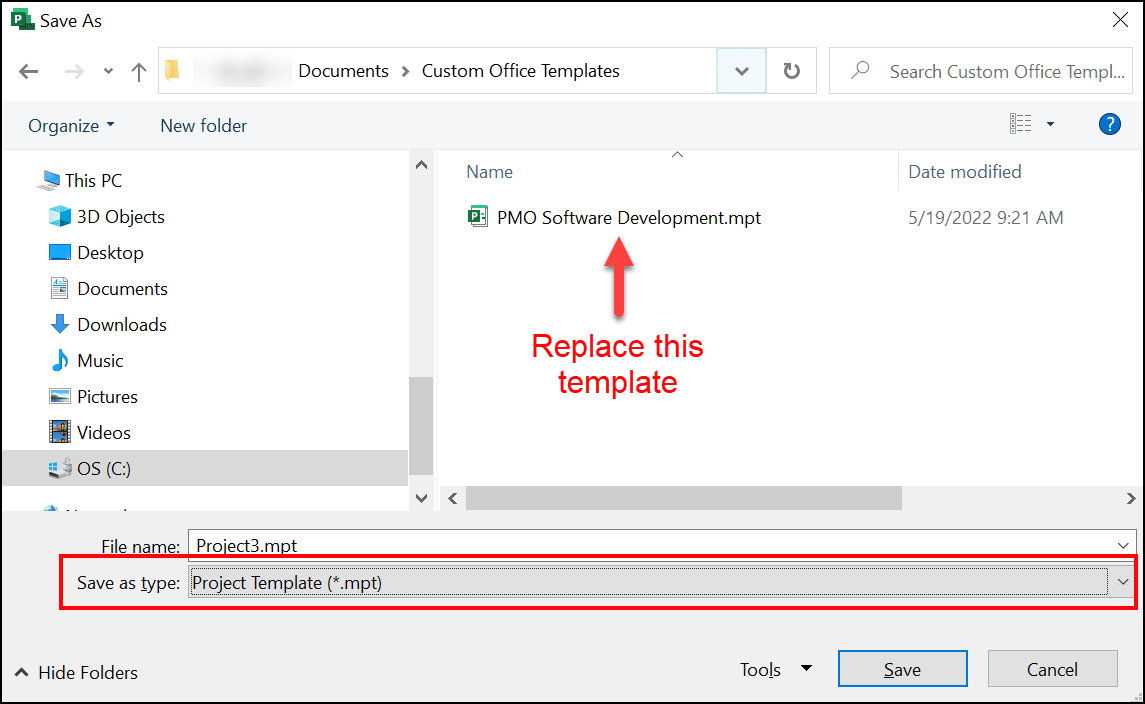

7. At the bottom of the Save As dialog, click the Save as type pick list and select the Project Template (*.mpt) item on the list, such as shown in Figure 5.

Figure 5: Select the Project Template file type

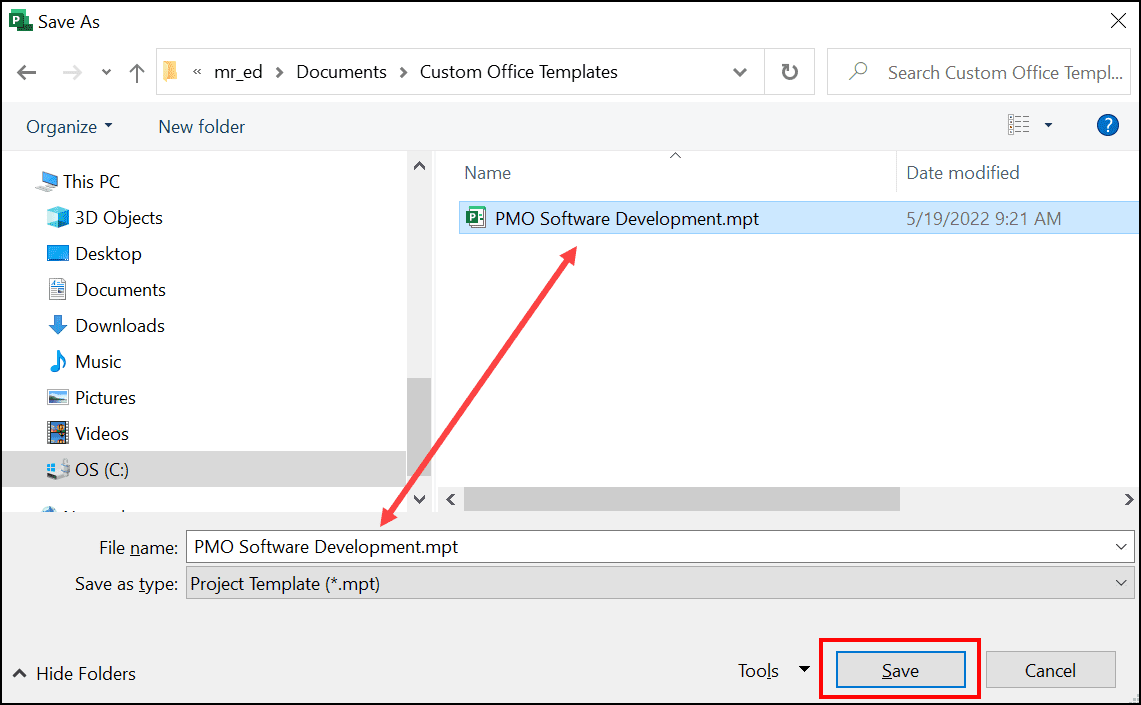

8. In the Save As dialog, click the name of the project template you want to replace with the updated version, such as shown in Figure 6, and then click the Save button.

Figure 6: Select the project template to replace

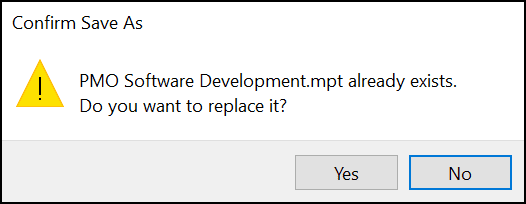

9. In the Confirm Save As dialog shown in Figure 7, click the Yes

Figure 7: Confirm Save As dialog

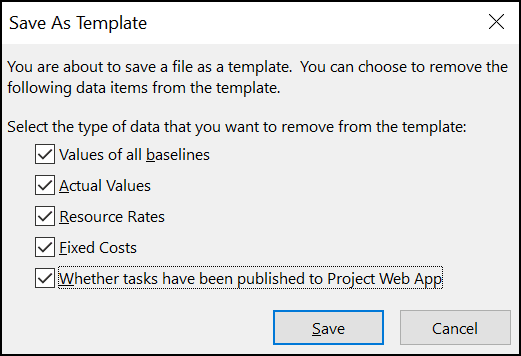

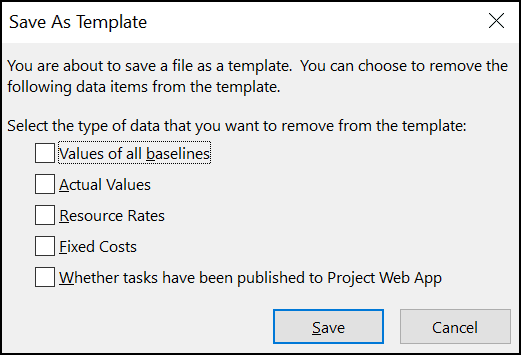

10. In the Save As Template dialog shown in Figure 8, select all of the relevant checkbox options for your project template. At a minimum, you should select at least the first two checkboxes. Click the Save button when finished.

Figure 8: Save As Template dialog

11. Close the updated template.

Solution for Users of Project Online or Microsoft Project Server

Complete the following steps to edit and save any existing enterprise project template using Microsoft Project Professional when connected to Project Online or Microsoft Project Server:

  1. Launch Microsoft Project and connect to your organization’s Project Web App.

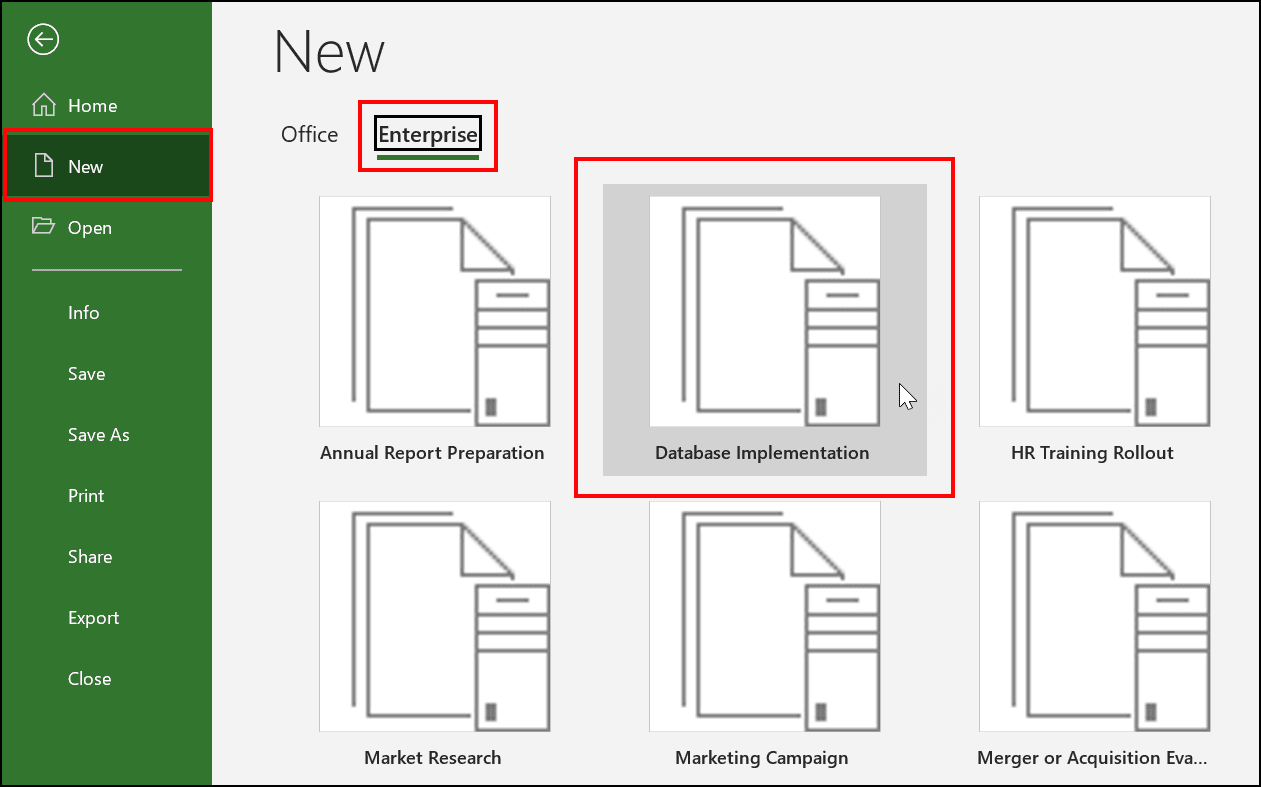

  2. Click the File tab, click the New tab in the Backstage, and then click the Enterprise tab. Click the name of the enterprise project template which you want to update and then create a new project from this template. For example, notice in Figure 9 that I am creating a new enterprise project from the Database Implementation enterprise template.

Figure 9: Create a new project from an enterprise template

3. Edit the project with any changes you want to see reflected in the updated enterprise project template. For example, you might need to add a new set of tasks to the template.

4. Click the File tab, click the Save As tab in the Backstage, and then click the Save button at the top of the Backstage, such as shown in Figure 10.

Figure 10: Save As page in the Backstage

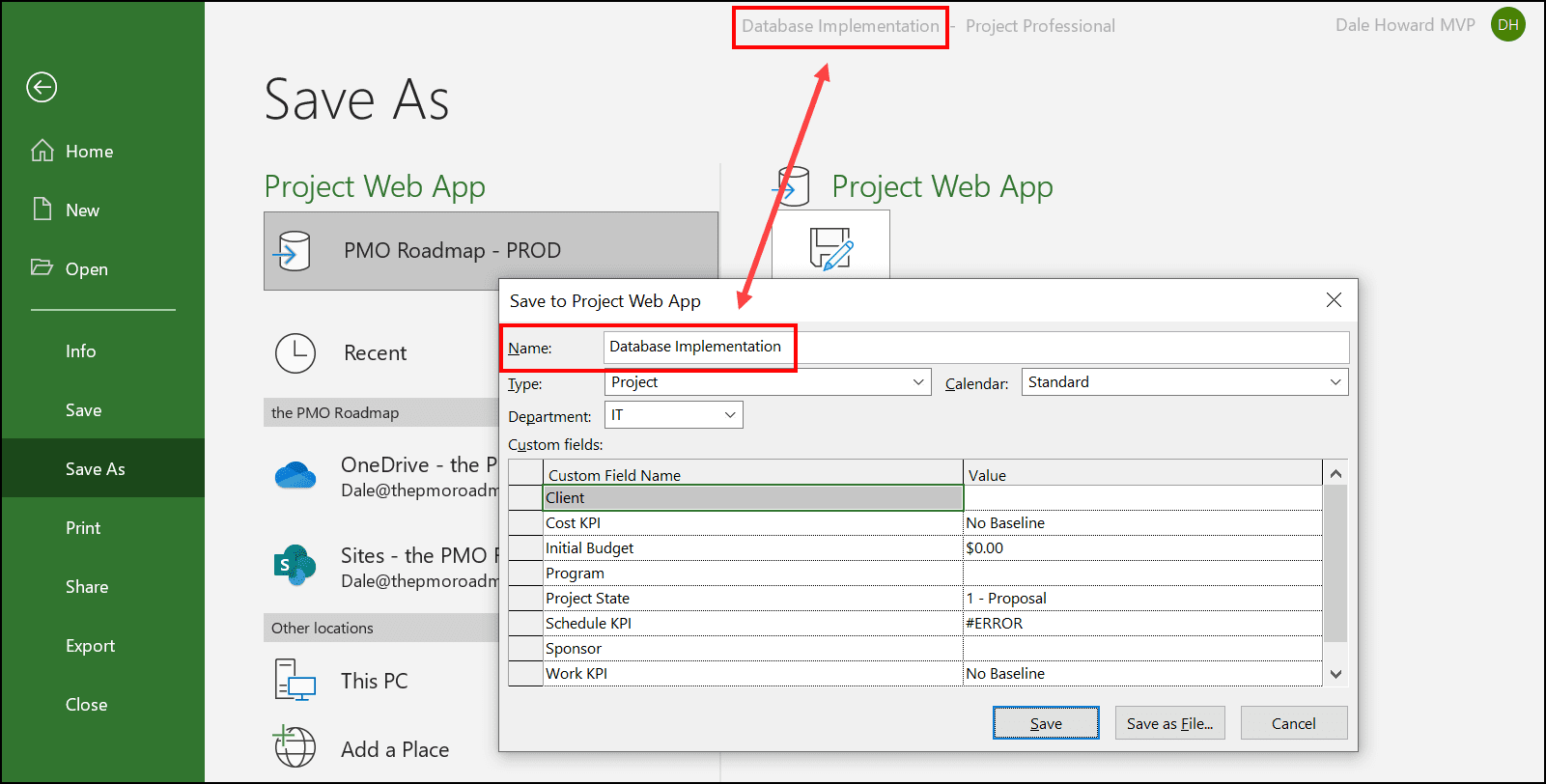

5. In the Save to Project Web App dialog, enter the exact same name as the template you are wanting to edit. Notice in Figure 11 that you will see the original template name displayed at the top of the Save As page.

Figure 11: Enter the original name of the template

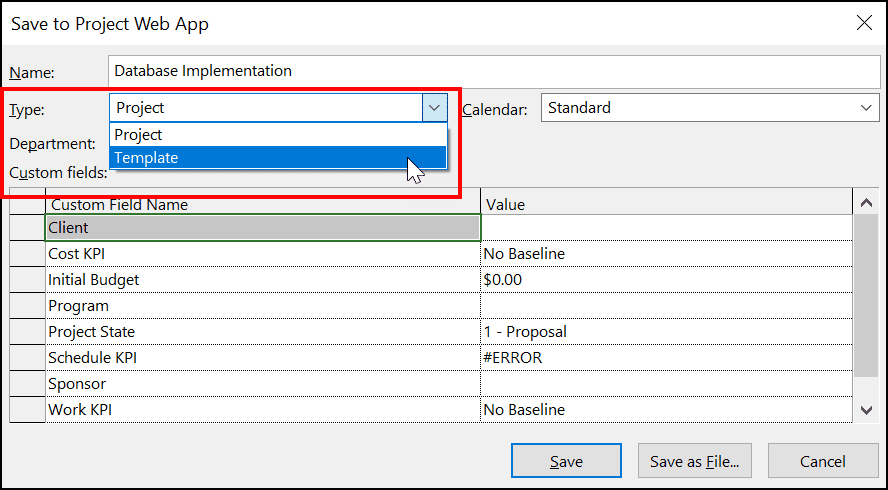

6. In the Save to Project Web App dialog, click the Type pick list and select the Template item, such as shown in Figure 12.

Figure 12: Select the Template type for the project

7. In the Custom Fields section of the dialog, specify any custom field settings you may want applied initially in the template.

8. In the Save to Project Web App dialog, click the Save button.

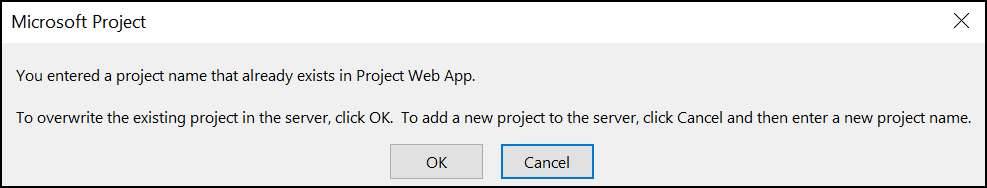

9. In the confirmation dialog about overwriting an existing project, such as shown in Figure 13, click the OK button.

Figure 13: Confirmation dialog

10. In the Save As Template dialog, select all of the checkboxes such as shown in Figure 14, and then click the Save button.

Figure 14: Save as Template dialog

11. When the Save job is completed, close the updated enterprise project template.

Get Weekly PM Insights

Join 50,000+ PMs receiving updates on the latest PM methodologies, PDU opportunities, tool reviews, career tips, and member exclusives.

Protected by reCAPTCHA: Privacy & Terms

PMI ATP
PMI Authorized Training Partner
REP #4082

Learning Paths

PMP® TrainingCAPM® TrainingPgMP® TrainingPMI-ACP® TrainingMS ProjectMS PlannerMS TeamsJira

PM Resources

PDU TrackerLive WebinarsSalary CalculatorTool ComparisonsJob BoardKnowledge BasePM GlossaryOur Faculty

Community

Discussion ForumStudy GroupsEvents Calendar

Follow Us

LinkedInYouTubeTwitterFacebook
MPUGMaster Project User Group

© 2026 MPUG. All rights reserved.

TermsPrivacySitemapAdvertise
Articles

Update and Save an Existing Project Template in Microsoft Project

Background Information I answered a question recently in the Tech Community Project user forum about how to edit an existing enterprise template in Project Online. That user’s question, and the […]

5 min read
•over 4 years ago•Updated 10 months ago•
D
Dale HowardAuthor
Project Management
Microsoft Project
Best Practices
Productivity
D
Dale Howard

Content Writer

Dale Howard is currently a Senior PPM Consultant with Arch Systems, Inc. His hair and beard have turned white because of using Microsoft's project management tools for more than 20 years. Dale started his career using Microsoft Project 4.0 for Windows 95 and began using Microsoft's PPM tools when they introduced Project Central in 2000. Dale is the co-author of 23 books in Microsoft Project, Project Server, and Project Online. He is currently one 0f 26 Microsoft Project MVPs in the entire world and one of only 4 Project MVPs in the United states.

View all articles by Dale Howard
Related Content

Continue Reading

Discover more insights and articles that complement your current reading

Collaboration challenges in remote projects (and how to fix each one)
Articles
1 min read

Collaboration challenges in remote projects (and how to fix each one)

Discover 5 common remote project collaboration challenges, from knowledge silos to unclear ownership, and learn practical ways to keep teams aligned and work moving.

A
Anonymous
10 days ago
Read
An Introduction to the PMI Practice Standard for Scheduling Conformance Index
Articles
1 min read

An Introduction to the PMI Practice Standard for Scheduling Conformance Index

Learn how the Conformance Index in PMI’s Practice Standard for Scheduling scores a CPM schedule model, and how to assess its components in any scheduling tool.

A
Anonymous
21 days ago
Read
A PM’s Halloween Survival Guide: The Sequel You Didn’t Want but Definitely Need
Articles
1 min read

A PM’s Halloween Survival Guide: The Sequel You Didn’t Want but Definitely Need

Part II of the PM Halloween survival guide takes on shape-shifting requirements and dependencies that won’t stay resolved, with practical defenses for each.

A
Anonymous
about 1 month ago
Read
Explore All Articles
