Setting Up a Project File: Microsoft Project Templates, Shortcuts and Best Practices

Introduction

For my commentary, I am using Microsoft Project – 2019 Professional desktop edition which can work with Project Online and Project Server. Some of the new and improved features of the 2019 Professional edition include improved task linking, timeline view updates, task Summary Name field added, and accessibility improvements.

Starting a New Plan

For a new project, do not start with a Blank Project template so you can avoid reinventing the wheel! Your project might be a unique endeavor but there are many similar projects that have the basic tasks you can use even though you will have to update the dates and resources. Templates (*.mpt) are often used as a basis for a new file (*.mpp) because they contain features that are common to other projects. Just edit the tasks, names, dates (e.g., Start) and so on to fit your current project. Numerous pre-built templates come with Project to help you get your project started on the right track and your organization might have a library of templates. Plus, you can find more templates on many websites (for example, MPUG and Microsoft Templates). Also, Project has an option for specifying your template folder – File tab > Options > Save to see Save templates folder (Browse for more folders) shown below – Table 1. From this you can find the templates that you created or downloaded so other PMs in your organization can use.

Customize how projects are saved and save templates in MS Project Professional Desktop Edition
Table 1 – Save Templates

Tip: Before starting your new plan, make sure your scope statement clearly defines what elements are not in scope to help you avoid scope creep (or ballooning) which will increase the financial plan, timetable, and updating/editing your project plan. Later, If the stakeholders decide they want an additional “pet deliverable,” they will have to decide whether the request is worth the price or should be moved to a follow-up project.

­­­

Key Aspects of Your New Project

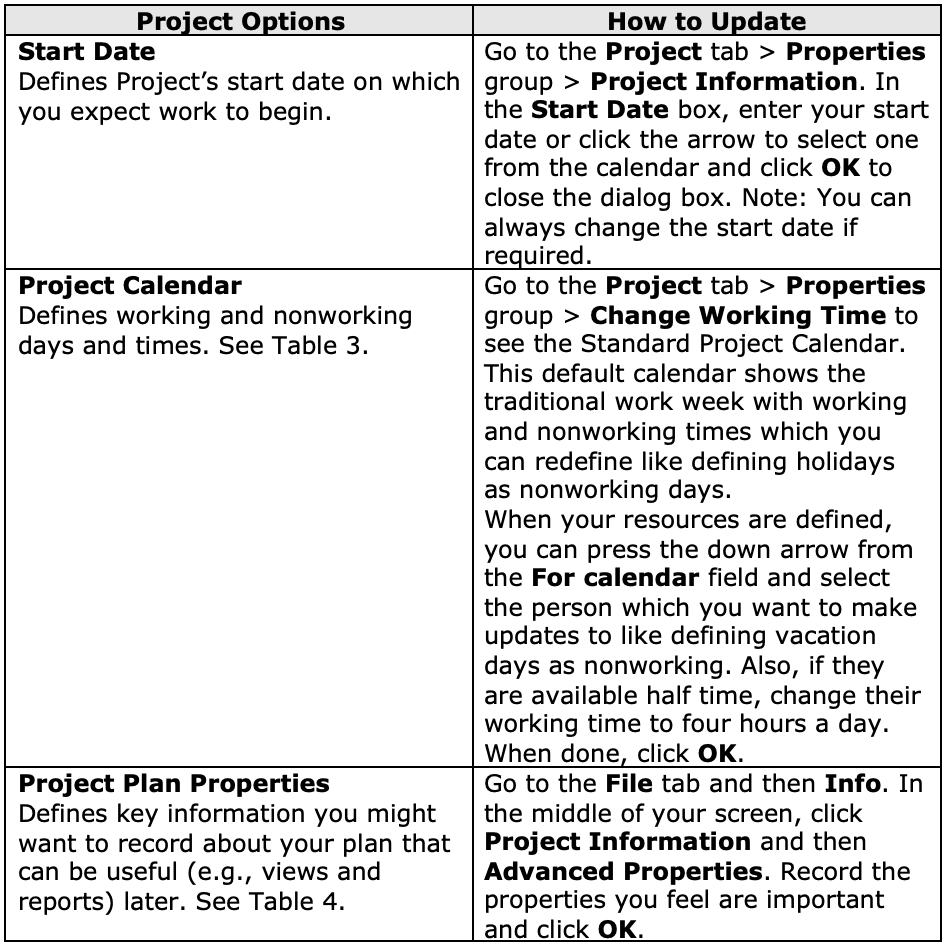

Table showing key aspects of a new project and how to update them in in MS Project Professional Desktop Edition
Table 2 – Initial Assets

Tip: When you complete the above updates, always remember to save your file or you can do it automatically by going to File tab > Options > Save and clicking Auto save every “10” minutes or any other time interval you choose. When done, click OK.

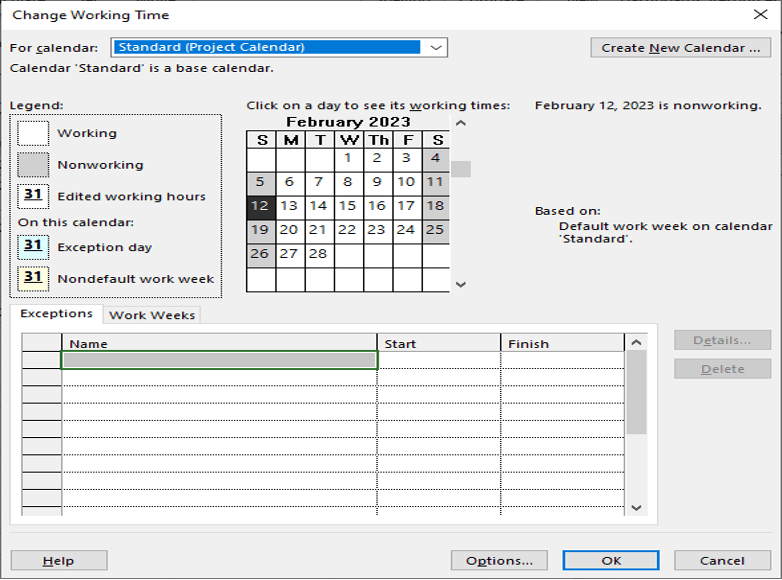

How to change working time in MS Project Professional Desktop Edition
Table 3 – Change Working Time

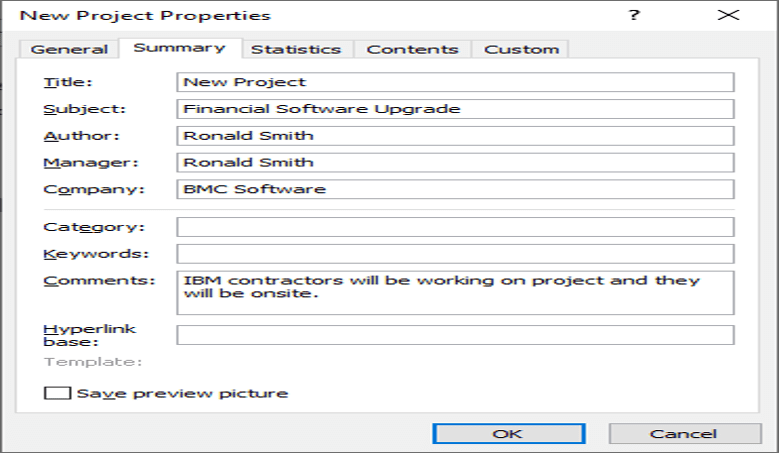

How to view and edit new project properties in MS Project Professional Desktop Edition
Table 4 – Project Properties

Keyboard Shortcuts

Microsoft Project has over five dozen keyboard shortcuts that will save you time. The following popular shortcut keys on Table 5 should save you much time when building and working on your project’s schedule.

Popular keyboard shortcuts in MS Project Professional Desktop Edition
Table 5 – Popular Keyboard Shortcuts in Microsoft Project

Tip: If you are having problems that Project Help (F1) can’t resolve, then you should try the Microsoft Support website (https://support.microsoft.com) or use your favorite search engine. Type in the error message (or number) or keywords that describe your problem.

Summary

The above tips should get you off to a good start in developing your project plan. A good article to read on this topic is from MPUG’s Praveen Malik – The Best Ten MSP Tips. Included is a tip about changing the task scheduling default mode from Manually Scheduled to Auto Scheduled so task dates are calculated by Microsoft Project.

If you have any other suggestions on starting up your project plan, your thoughts would be much appreciated.

Get Weekly PM Insights

Join 50,000+ PMs receiving updates on the latest PM methodologies, PDU opportunities, tool reviews, career tips, and member exclusives.

Protected by reCAPTCHA: Privacy & Terms

PMI ATP
PMI Authorized Training Partner
REP #4082

Learning Paths

PMP® TrainingCAPM® TrainingPgMP® TrainingPMI-ACP® TrainingMS ProjectMS PlannerMS TeamsJira

PM Resources

PDU TrackerLive WebinarsSalary CalculatorTool ComparisonsJob BoardKnowledge BasePM GlossaryOur Faculty

Community

Discussion ForumStudy GroupsEvents Calendar

Follow Us

LinkedInYouTubeTwitterFacebook
MPUGMaster Project User Group

© 2026 MPUG. All rights reserved.

TermsPrivacySitemapAdvertise
Articles

Setting Up a Project File: Microsoft Project Templates, Shortcuts, and Best Practices

Learn how to set up a project file in Microsoft Project 2019 Professional desktop edition using templates, key aspects, and shortcuts.

3 min read
•over 3 years ago•Updated 10 months ago•
R
Ronald B. Smith, MBA, PMPAuthor
Project Management
Microsoft Project
Best Practices
Productivity
R
Ronald B. Smith, MBA, PMP

Content Writer

Ronald Smith has over four decades of experience as Senior PM/Program Manager. He retired from IBM having written four books and over one hundred articles on project management, and the systems development life cycle (SDLC). He’s been a member of the Project Management Institute (PMI) since 1998, which has a membership of about 3 million professionals worldwide. From 2011 - 2017, Ronald had been an Adjunct Professor for a Master of Science in Technology and taught PM courses at the University of Houston’s College of Technology. Teaching from his own book, Project Management Tools and Techniques – A Practical Guide, Ronald offers a unique perspective on project management that reflects his many years of experience. Besides writing, he swims five times a week to keep in shape. Lastly in the Houston area, he has started up two Toastmasters clubs and does voluntary work at various food banks to help people facing hunger.

View all articles by Ronald B. Smith, MBA, PMP
Related Content

Continue Reading

Discover more insights and articles that complement your current reading

Collaboration challenges in remote projects (and how to fix each one)
Articles
1 min read

Collaboration challenges in remote projects (and how to fix each one)

Discover 5 common remote project collaboration challenges, from knowledge silos to unclear ownership, and learn practical ways to keep teams aligned and work moving.

A
Anonymous
10 days ago
Read
An Introduction to the PMI Practice Standard for Scheduling Conformance Index
Articles
1 min read

An Introduction to the PMI Practice Standard for Scheduling Conformance Index

Learn how the Conformance Index in PMI’s Practice Standard for Scheduling scores a CPM schedule model, and how to assess its components in any scheduling tool.

A
Anonymous
22 days ago
Read
A PM’s Halloween Survival Guide: The Sequel You Didn’t Want but Definitely Need
Articles
1 min read

A PM’s Halloween Survival Guide: The Sequel You Didn’t Want but Definitely Need

Part II of the PM Halloween survival guide takes on shape-shifting requirements and dependencies that won’t stay resolved, with practical defenses for each.

A
Anonymous
about 1 month ago
Read
Explore All Articles
