Don M. of Bozeman, MD asks: Our projects are performed by multiple departments within our organization. How can I get a Gantt chart and task list per department?

It’s a little known feature of the system that the Resource Group field in the Task tables is populated from the Resource Groups field on the Resource Sheet when an assignment is made to a task. If you insert the column, “Resource Group,” into any task table, you’ll see the values on tasks that contain assignments. This means that how you design the use of the Resource Grouping field could have an impact on the task reports you’ll be able to obtain.

Obtaining a report for a single resource group would best be accomplished using filters applied to a task table with or without a Gantt chart view. Grouping is another possibility, but if you have multiple resources assigned from different groups, grouping will not separate the individual values. Filters have the ability to show individual group values. The easiest solution is to insert the Resource Group field into a task table, turn on the autofilter and then filter on the required group requested. Another option would be to create a filter that would allow you to select the group you would like at the time you executed the request. Another advantage of creating a filter is that it can be applied to reports as well as views. See below for both options.

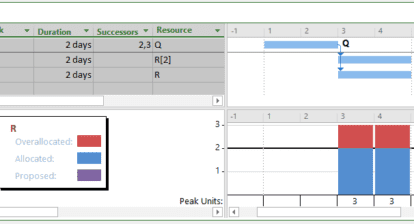

Autofilter:

How to Report Tasks by Department/Group
Create a custom filter with an execution time selection option:

Tools | Filter | more filters | New

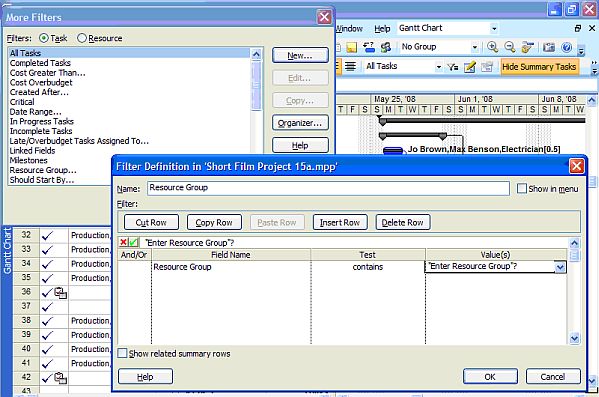

In the Filter definition form enter the values as shown on screen below:

How to Report Tasks by Department/Group
Name: Resource group
Show in the menu: click to put in a check mark
Field Name: Resource Group
Test: Contains
Value: “Enter Resource Group”?
Click OK.

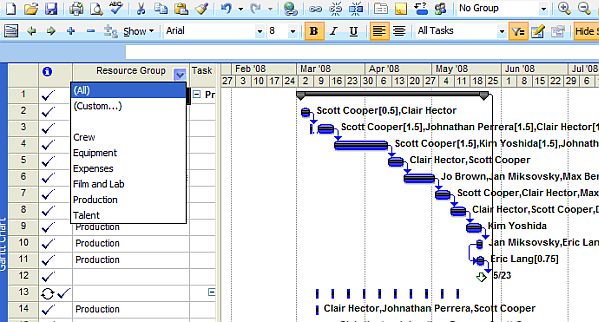

Project | Filters | Resource Group or select Resource Group from the filter selector on the formatting toolbar. The column Resource Group doesn’t have to be in the table to run the filter. This filter may now be applied to reports as well as views.

Shortcut! The F3 key will remove any filter.

[mpug_related_article]

Get Weekly PM Insights

Join 50,000+ PMs receiving updates on the latest PM methodologies, PDU opportunities, tool reviews, career tips, and member exclusives.

Protected by reCAPTCHA: Privacy & Terms

PMI ATP
PMI Authorized Training Partner
REP #4082

Learning Paths

PMP® TrainingCAPM® TrainingPgMP® TrainingPMI-ACP® TrainingMS ProjectMS PlannerMS TeamsJira

PM Resources

PDU TrackerLive WebinarsSalary CalculatorTool ComparisonsJob BoardKnowledge BasePM GlossaryOur Faculty

Community

Discussion ForumStudy GroupsEvents Calendar

Follow Us

LinkedInYouTubeTwitterFacebook
MPUGMaster Project User Group

© 2026 MPUG. All rights reserved.

TermsPrivacySitemapAdvertise
Articles

How to Report Tasks by Department/Group

Don M. of Bozeman, MD asks: Our projects are performed by multiple departments within our organization. How can I get a Gantt chart and task list per department? It’s a […]

2 min read
•almost 19 years ago•Updated 10 months ago•
E
Ellen LehnertAuthor
Project Management
Microsoft Project
Best Practices
Productivity
E
Ellen Lehnert

Content Writer

Ellen Lehnert, PMP, Microsoft Project MVP, MCP, is a independent consultant and trainer on Microsoft Project and Project Server. She has taught Microsoft Project over 400 times and is the author of  MS Project 2010 and 2013 published courseware. Ellen is also a contributor and tech editor for many reference books, a developer for the Microsoft Project certification tests and is a frequent meeting speaker for Microsoft, MPUG and PMI. Contact Ellen at ellen@lehnertcs.com.

View all articles by Ellen Lehnert
Related Content

Continue Reading

Discover more insights and articles that complement your current reading

Collaboration challenges in remote projects (and how to fix each one)
Articles
1 min read

Collaboration challenges in remote projects (and how to fix each one)

Discover 5 common remote project collaboration challenges, from knowledge silos to unclear ownership, and learn practical ways to keep teams aligned and work moving.

A
Anonymous
7 days ago
Read
An Introduction to the PMI Practice Standard for Scheduling Conformance Index
Articles
1 min read

An Introduction to the PMI Practice Standard for Scheduling Conformance Index

Learn how the Conformance Index in PMI’s Practice Standard for Scheduling scores a CPM schedule model, and how to assess its components in any scheduling tool.

A
Anonymous
19 days ago
Read
A PM’s Halloween Survival Guide: The Sequel You Didn’t Want but Definitely Need
Articles
1 min read

A PM’s Halloween Survival Guide: The Sequel You Didn’t Want but Definitely Need

Part II of the PM Halloween survival guide takes on shape-shifting requirements and dependencies that won’t stay resolved, with practical defenses for each.

A
Anonymous
about 1 month ago
Read
Explore All Articles
