As a proficient project manager, you’re well-versed in the complexities of task dependencies in Microsoft Project. The strategic implementation of graphical indicators to flag tasks without predecessors or successors significantly enhances project tracking efficiency. This comprehensive guide provides detailed instructions on creating these indicators and steps to identify tasks with date constraints, offering a sophisticated approach to project management.

Step 1: Define the Custom Field for Dependency Check

  1. Open Microsoft Project and select your project.
  2. Navigate to Project Tab > Custom Fields.
  3. Choose ‘Text’ as the field type and select a field, such as Text1.
  4. Rename the field to “Dependency Check”.

Step 2: Construct the Formula for Dependency Check

  1. Click on ‘Formula’ in the Custom Fields dialog.
  2. Enter the Formula to check for missing predecessors or successors:lessCopy codeIIf(IsNull([Predecessors]), "No Predecessor", IIf(IsNull([Successors]), "No Successor", "OK"))
  3. Handle Errors appropriately, such as selecting Return a 0 for error conditions.
adding custom formula to identify missing predecessor in ms project
Adding a custom formula to identify missing predecessor in MS Project.

Step 3: Set Up the Graphical Indicator for Dependency Check

  1. Access Graphical Indicator Settings in the Custom Fields dialog.
  2. Configure the Rules based on the formula’s output, such as using a red flag for “No Predecessor” and a yellow flag for “No Successor”.

Step 4: Implementing the Dependency Indicator in Your Project Views

  1. Add the Custom Field (“Dependency Check”) to your task sheet or desired view by inserting it as a column.

Enhancing Project Management with Date Constraint Indicators

To further augment your project management capabilities, integrating graphical indicators for date constraints in Microsoft Project is a significant enhancement. This feature brings another layer of visual clarity and efficiency to the management of project schedules. Crucial in determining the flow and success of a project, date constraints can often be lost in the myriad of tasks and milestones. By visually highlighting these constraints, you gain an immediate awareness of critical deadlines and scheduling commitments.

This integration not only aids in maintaining a clear view of the project’s timeline but also serves as a proactive tool for identifying potential scheduling conflicts. It enables project managers to quickly spot where rigid deadlines may impact other aspects of the project, allowing for timely adjustments and negotiations. Moreover, in large-scale projects with numerous stakeholders, these indicators provide a straightforward way to communicate the urgency and importance of specific tasks, fostering a shared understanding of project priorities.

In essence, the incorporation of graphical indicators for date constraints is not just a tool for simplification; it’s a strategic asset that enhances your ability to manage, adapt, and communicate the complexities of project timelines more effectively.

Step 1: Define a Custom Field for Date Constraint Check

  1. Create another Custom Field named “Date Constraint Check” following the same steps as for the Dependency Check.

Step 2: Crafting the Formula for Date Constraint Check

  1. Input the Formula to identify tasks with date constraints:graphqlCopy codeIIf([Constraint Type] <> "As Soon As Possible", "Constraint Set", "No Constraint")
  2. Error Handling: Opt for an appropriate error handling mechanism.

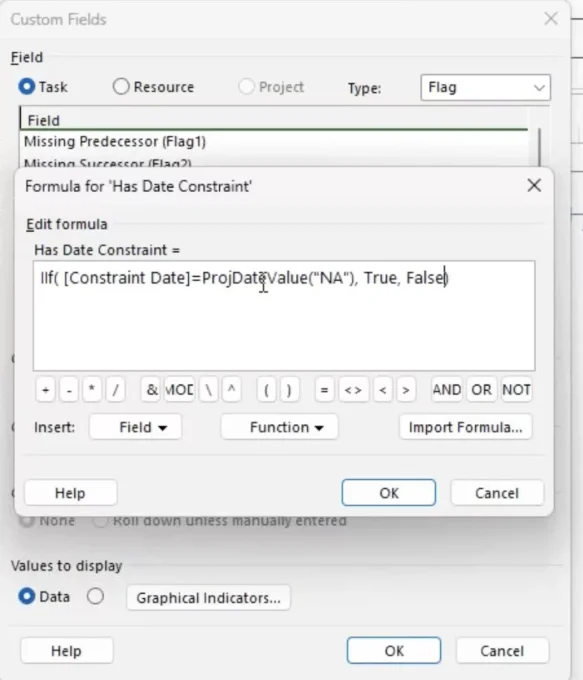

Adding a custom function to identify date constraints in MS Project
Adding a custom function to identify date constraints in MS Project.

Step 3: Configuring Graphical Indicators for Date Constraint Check

  1. Set up the Graphical Indicators with specific icons to indicate tasks with set constraints.

Step 4: Implementing the Date Constraint Indicator in Views

  1. Add the “Date Constraint Check” field to your project views to identify tasks with date constraints easily.

Result
Result.

Real-World Application

In complex projects or those with continuous task additions, these indicators serve as an essential tool for ensuring no task is overlooked, maintaining the integrity of your project’s timeline. The additional layer of date constraint indicators aids in highlighting potential rigidity in your schedule, allowing for proactive adjustments.

Conclusion

For the seasoned project manager, such customizations in Microsoft Project not only streamline the management process but also enhance the accuracy and efficiency of project execution. By implementing these graphical indicators, you ensure a proactive approach to task management, keeping your projects on track and aligned with planned timelines and dependencies.

Get Weekly PM Insights

Join 50,000+ PMs receiving updates on the latest PM methodologies, PDU opportunities, tool reviews, career tips, and member exclusives.

Protected by reCAPTCHA: Privacy & Terms

PMI ATP
PMI Authorized Training Partner
REP #4082

Learning Paths

PMP® TrainingCAPM® TrainingPgMP® TrainingPMI-ACP® TrainingMS ProjectMS PlannerMS TeamsJira

PM Resources

PDU TrackerLive WebinarsSalary CalculatorTool ComparisonsJob BoardKnowledge BasePM Glossary

Community

Discussion ForumStudy GroupsEvents Calendar

Follow Us

LinkedInYouTubeTwitterFacebook
MPUG Logo

© 2026 MPUG. All rights reserved.

TermsPrivacySitemapAdvertise
Articles

Enhanced Project Management in Microsoft Project: Incorporating Graphical Indicators for Task Dependencies and Date Constraints

As a proficient project manager, you’re well-versed in the complexities of task dependencies in Microsoft Project. The strategic implementation of graphical indicators to flag tasks without predecessors or successors significantly […]

3 min read
•over 2 years ago•Updated 3 months ago•
I
Ira BrownAuthor
Project Management
Microsoft Project
Best Practices
Productivity
I
Ira Brown

Content Writer

Ira Brown is a leader in the field of project management and a recognized Microsoft Project expert, Project Widgets is well-known for offering add-on products for Microsoft Project and Project Online, as well as for creating custom solutions that meet their client's unique business requirements.  This company continues to extend the scope and breadth of their offerings, thereby increasing the value they provide to customers, by creating Microsoft Project solutions that are tailored to an organization's unique needs.  They even have several free, downloadable widgets available on their website that you can begin using right away.

View all articles by Ira Brown
Related Content

Continue Reading

Discover more insights and articles that complement your current reading

Are You Running a Risk Meeting or a Risk Workshop?
Articles
1 min read

Are You Running a Risk Meeting or a Risk Workshop?

Learn the difference between a risk meeting and a risk workshop, and why structured risk workshops help project teams identify owners, define actions, and protect project outcomes.

A
Anonymous
4 days ago
Read
&#8220;I Need a Dashboard by Friday&#8221; &#8211; How AI Just Made That Possible
Articles
1 min read

“I Need a Dashboard by Friday” – How AI Just Made That Possible

Need a dashboard by Friday? Discover how AI tools like ChatGPT can help you build an Excel dashboard quickly and easily—no advanced technical skills required. Learn how to turn plain-English requests into real, working reports with spreadsheets that actually work for you.

A
Anonymous
4 days ago
Read
Why Tools Matter More Than Ever in Project Management (And Why Most Organizations Still Get Them Wrong)
Articles
1 min read

Why Tools Matter More Than Ever in Project Management (And Why Most Organizations Still Get Them Wrong)

Most PPM tools fail because they’re built for oversight, not adoption. Here’s how to design for decisions instead, and why Smartsheet bridges the gap.

A
Anonymous
6 days ago
Read
Explore All Articles
