When I observe individuals using Microsoft Project, I sometimes see them using techniques that don’t optimize the features available. An example of such a technique is when someone changes the start date of the first task when he or she really wanted to move the entire project. This typically leads to adding a task constraint and locking in a date instead of letting the software calculate the date. As you may know, locking in a task limits the ability to flexible adjustments later on in the software.

What I recommend as an alternative is choosing between one of the two built-in options to postpone a project. Before I explain these options, let’s explore a few reasons why you might postpone a project.

There’s been a funding delay. If an internal approval is delayed or if a business has failed to raise enough funds to start the project, a delay may be needed.

The decision has been delayed. If a key sponsor or stakeholder on the project hasn’t made a critical decision, this may delay the project.

The agency has created the delay. If the organization is in an industry with regulation — construction, health care, finance, movies — there are often certifications that must be obtained to authorize work. If the individuals, businesses, equipment or facilities can’t obtain these certifications, this may delay the project.

Available in the last few versions of Microsoft Project, you have two ways to postpone a schedule. Both of these options are available on the Project tab of the Ribbon.

You may choose to move the scheduled start date only or move the scheduled start date and incrementally move deadlines and constraints.

Move the Scheduled Start Date Only

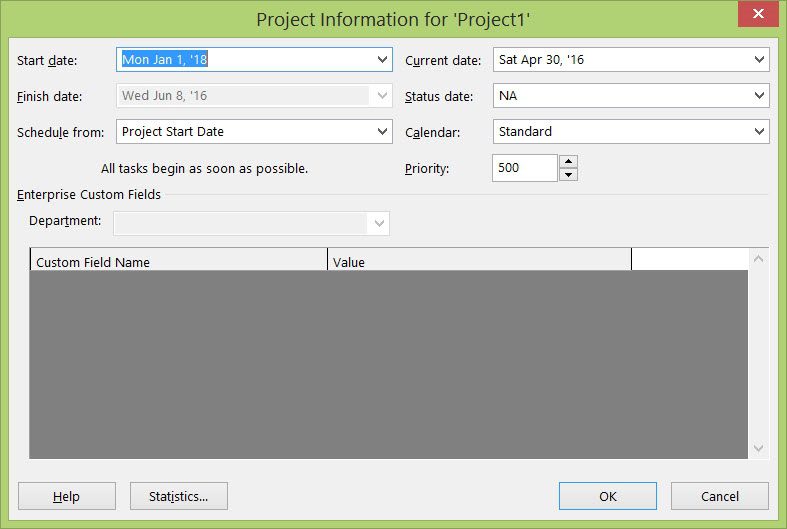

This option shifts the start date of all tasks scheduled to begin the day the project starts. It also dynamically shifts any tasks that are linked together. Deadlines and locked-in constraints on the schedule don’t change.

Cindy_Lewis_Postponing_a_schedule_figure_1
Cindy_Lewis_Postponing_a_schedule_figure_2

Move the Scheduled Start Date and Incrementally Move Deadlines and Constraints

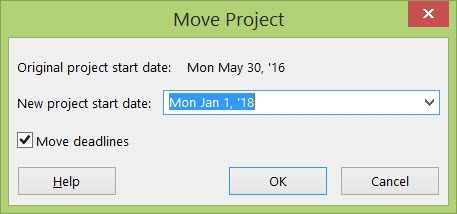

This option shifts the start date of all tasks scheduled to begin the day the project starts. Deadlines and locked-in constraints on the schedule move the same distance. If the project start date moves 30 days, all deadlines and constraints on the project also move 30 days.

Cindy_Lewis_Postponing_a_schedule_figure_3
Cindy_Lewis_Postponing_a_schedule_figure_4

The dialog box doesn’t specify that constraints are moving, but they definitely do. You may want to test this yourself.

While many of us hope our projects start on time, it’s good to know that we have options available when they can’t.

Which option do you prefer to use? Share your reasons why in the comments below.

A version of this article originally appeared on Cindy Lewis’ blog, “4 Pillars of Success“.

Image Source

Get Weekly PM Insights

Join 500,000+ PMs receiving updates on the latest PM methodologies, PDU opportunities, tool reviews, career tips, and member exclusives.

PMI ATP
PMI Authorized Training Partner
REP #4082

Learning Paths

PMP® TrainingCAPM® TrainingPgMP® TrainingPMI-ACP® TrainingMS ProjectMS PlannerMS TeamsJira

PM Resources

PDU TrackerLive WebinarsSalary CalculatorTool ComparisonsJob BoardKnowledge BasePM Glossary

Community

Discussion ForumStudy GroupsEvents Calendar

Follow Us

LinkedInYouTubeTwitterFacebook
MPUG Logo

© 2025 MPUG. All rights reserved.

TermsPrivacySitemap
Articles

2 Ways to Postpone Your Microsoft Project Schedule

When I observe individuals using Microsoft Project, I sometimes see them using techniques that don’t optimize the features available. An example of such a technique is when someone changes the […]

3 min read
•about 9 years ago••
C
Cindy M. LewisAuthor
Project Management
Microsoft Project
Best Practices
Productivity
C
Cindy M. Lewis

Content Writer

Cindy Lewis is an awarded Microsoft Project MVP and an expert in scheduling with a long history in project management. She holds numerous credentials in the field including: PMP, PMI-SP, MS, MOS, and MCT. She serves on the board of the MPUG Detroit chapter and is a frequent speaker at conferences and events across the country . Cindy’s personal passion is sharing knowledge with others and helping them grow and achieve personal success. Her training philosophy is known as the 4 Pillars of Success® which is also the name of her company. Feel free to connect with Cindy on social media or contact her directly through her website www.4pillarsofsuccess.com.

View all articles by Cindy M. Lewis
Related Content

Continue Reading

Discover more insights and articles that complement your current reading

Two Project Manager Agent Features You Might Like
Articles
5 min read

Two Project Manager Agent Features You Might Like

Discover two game-changing features of Microsoft’s Project Manager Agent including agent-to-agent communication and the new integrated interface in Planner.

E
Erik van Hurck
about 1 month ago
Read
Master Dependency Analysis in Microsoft Project with SSI Tools!
Articles
2 min read

Master Dependency Analysis in Microsoft Project with SSI Tools!

Learn how to master dependency analysis in Microsoft Project using SSI Tools’ Directional Path, Connecting Path, and Dependency Tracer to analyze predecessors, successors, and project logic.

K
Kenny Arnold
about 1 month ago
Read
A PM’s Halloween Survival Guide
Articles
5 min read

A PM’s Halloween Survival Guide

Discover the spooky parallels between Halloween and project management, from scope creep monsters to ghosted team members, in this fun survival guide for PMs.

R
Ronald B. Smith, MBA, PMP
2 months ago
Read
Explore All Articles
